Tracking unit progress on ms project

I am trying to figure out how to get MSP to measure my work correctly. Example: I have 10 days to install 10,000 feet of cable. On day one I install 2500 feet and put my progress in as 25%. The problem is my task bar and days show 2.5 days have been used which is incorrect. I want to see my actual percent complete based on the actual amount of time (days) I use. It can work the other way. I can take 3 days to lay 1000 ft. I don't want my task bar to say I've only used one day when I actually used 3 days. Please help. Shawman

  • shawman60

    Sorry but that's not how the progress line on the Gantt bar works. Percent complete is a duration based parameter so if you enter 25% for a 10 day task, Project will show 2.5 days of progress. Agreed, not a very useful metric.

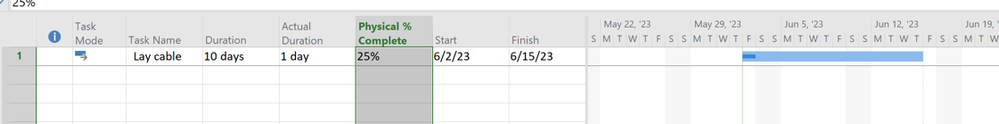

    Here's what you can do. Show the Actual Duration field and the Physical % Complete fields, hide the Percent Complete field. Then you can enter the number of days and whatever percentage of work you feel is complete.

    Hope this helps.

    John

3 Replies

  • John-project's avatar
    John-project
    Silver Contributor

    shawman60

    Sorry but that's not how the progress line on the Gantt bar works. Percent complete is a duration based parameter so if you enter 25% for a 10 day task, Project will show 2.5 days of progress. Agreed, not a very useful metric.



    Here's what you can do. Show the Actual Duration field and the Physical % Complete fields, hide the Percent Complete field. Then you can enter the number of days and whatever percentage of work you feel is complete.

    Hope this helps.

    John

    • shawman60's avatar
      shawman60
      Copper Contributor

      I will make that work and assign physical % complete to my task bars on gantt chart - Thanks for your help John-project
