Rescheduling unachieved task

Hello,



I am facing the following issue with MS PROJECT 2016 :

- the recalculate of the project does not take into account the % work achieved and still keep the initial amount of work dispite an "Update project" for uncompleted tasks.



Any idea ?



Thanks



  • John-project's avatar
    John-project
    Silver Contributor

    Philippe_Bierler

    How exactly are you updating? The Update Project feature allows you to reschedule uncompleted work after a date you select. Is that not working for you?



    A more detailed explanation of your issue with some screen shots would help us help you.



    John

    • Philippe_Bierler's avatar
      Philippe_Bierler
      Copper Contributor

      John-project



      Hi John,



      To simplify I only kept 1 task / 1 resources and cleaned the entire project file:

      AUTOMATIC SCHEDULE/FIXED WORK/NO CONSTRAINT DATE

      WORK = 100 md / % COMPLETED 90 % ==> remaining work 10 md

      Task assigned to one single resource 100% available

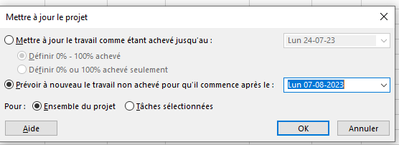

      I UPDATED THE ENTIRE PROJECT asking to reschedule the remaining work after August 7th

      Result is not correct : the task finish date is set to October 27th !

      Looking at the resource allocation : +/- 70 md assigned for a remaining work of 10 md !

      I do not know where I missed something ...



      Thanks for your support



      Philippe











      • John-project's avatar
        John-project
        Silver Contributor

        Philippe_Bierler

        The first screen shot shows a task start date of 4/17/23 and a duration of 125 days. With a Standard calendar that should give a finish date of 10/6/23 but your screen shot shows a finish date of 10/27/23. That tells me there must be some holidays or other non-working time during that time span.



        The screen shot also shows a work content of 100 days yet the resource is assigned 100% so the work should be 125 days. Perhaps the resource work calendar is different from the Project calendar.



        The plan is updated to reschedule uncompleted work after 8/7/23 but that will have no impact on the task because the task is already 90% complete so uncompleted work is already scheduled beyond that date, namely the last couple weeks of Sept and the first week of Oct.



        Everything works okay for me. What exactly are you expecting?

        John
