Overallocation and scheduling conflicts - Project Desktop
Hello, I have an issue with marked overallocation in some tasks with predecessors (3 activities unfold in the same day of 8 hours, one of them continuing in the following days) for some resources which do not seem to over overallocated in that period, the allocation sum in the corresponding period being <=100
Yet, there appear some scheduling conflict errors, reported for the last tasks in the flow (following the predecessors - successors activities), these last tasks being scheduled much later than the ones with overallocation
The message in Inspector is 'Resources assigned in nonworking time' - for the 2 resources with marked overallocation. Yet, the days with overallocation are working days.
Could the problem appear from the scheduling conflicts? Actually I do not see clearly the scheduling conflicts as well
And then how are these overallocations computed?
Could you please help me solve this issue?
If necessary, I can attach the Project file
Thank you very much!

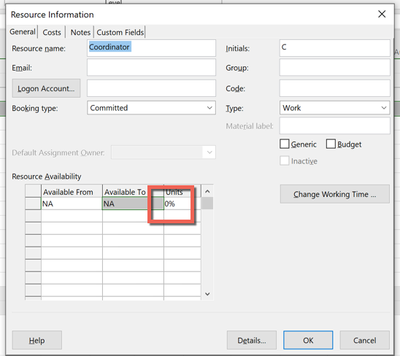

Not to upstage any analysis Dale might provide, but I took a quick look at your file. On the Resource Usage view, take a look at Work Availability in the Details column for the Coordinator resource. It shows as zero. If you then look at Resource Availability on the Resource Information you will see it is set to 0%. The same is true for the Beneficiary resource. Fix those and you should be good to go.
John
- Alina --
I think we need to see your project, if you are willing to share it. I simply cannot visualize what is going on with your project. Let us know. Thanks!- Alina_AndreicaCopper Contributor
Dale_HowardMVP Hello Dale, and thank you for your answer
Actually, it's one of my students' project, but I cannot see why resources Coordinator and Beneficiary are overallocated in the subtasks of T5
Thank you very much!
- John-projectSilver Contributor
Not to upstage any analysis Dale might provide, but I took a quick look at your file. On the Resource Usage view, take a look at Work Availability in the Details column for the Coordinator resource. It shows as zero. If you then look at Resource Availability on the Resource Information you will see it is set to 0%. The same is true for the Beneficiary resource. Fix those and you should be good to go.
John
