Forum Discussion

RPLCAP's avatar
RPLCAP
Copper Contributor
May 17, 2024

Unable to open project plans I was previously accessing everyday

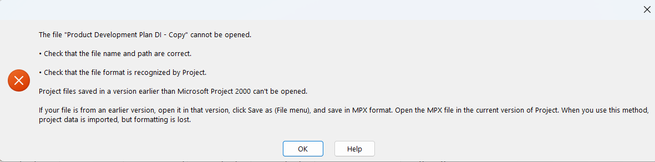

2 files I use are now inaccesseible to me, as opening them gives the below error message



How do I access these files again? The file name and paths are correct (other users in my organisation can see them but also not access them), and the file format is a standard MS project file. Other project files in this folder can be accessed as normal to. How do I resolve this issue?



(I am using the MS project desktop app, not office 365 version which I do not have access to)



1 Reply

  • John-project's avatar
    John-project
    Silver Contributor

    RPLCAP

    For reference which version of desktop Project are you using?



    Are the problem files part of a linked structure (i.e. master file with subprojects or resource pool with sharer files)?



    Where are the files stored (i.e. on a local drive or a remote server)?



    If the files are NOT part of a linked structure, try this:

    1. Open a new blank Project file
    2. Go to Project/Insert group/Subproject and insert one of the problem files.

    3. Select the first task which will be the insertion point summary line.

    4. Go to Task/Properties group/Information/Advanced tab.

    5. Uncheck the "Link to Project" button and hit "OK".

    6. If the file isn't already expanded, expand it.

    7. Select all tasks below the top level summary line.

    8. Outdent the selected tasks.

    9. Delete the first task which previously was a summary line.


    10. Save the resulting file.

    Can you now open the saved file? If so, perform this process for the other problem file.



    John
