Forum Discussion

naetroze's avatar
naetroze
Copper Contributor
Sep 28, 2024
Solved

resource over allocation in a Master Project

I'm working with Master Project, and some Sub projects.
Let's say Jack, is allocated at the same dates to tasks in different subproject, and at the same time to a task of the Master project.
I do use the "resource Pool" and also assign "Share resources". But this enables only to look at over allocation between Master Project and one of the Sub Projects.
Is there a way to see over allocation between all the sub projects, as an aggregated summary and red indication?

  • naetroze

    You didn't give me all the information I asked for, but fortunately, what you did give me, sheds light on the problem.



    The Resource Sheet tells us why you don't see any overallocation. It shows 2 Moses, 2 Hays, and 2 Jacobs. Just because the names are the same doesn't mean Project interprets them to be the same.  In fact, you have 2 of each resource.



    Linked structures in Project can be very problematic if not set up and maintained with utmost discipline. As such, they are prone to corruption. My guess is you either have not set up sharing properly between the master and two subprojects or you have created a corrupt link structure. Try this:

    1. Open the Share Resources window for each of the files, master, subproject 1, subproject 2 and the pool file, one at at time

    2. Go to, Resource > Assignments group > Resource Pool > Share Resources.

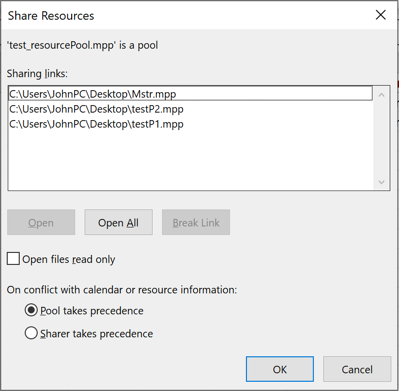

    3. For the master and each of the subprojects, you should see something like this

    4. For the pool file you should see something like this (i.e. 3 entries only)



    If you do not have what is shown above, you'll need to break corrupt links from the pool file and reset the structure.



    John

7 Replies

  • John-project's avatar
    John-project
    Silver Contributor

    naetroze,
    What view are you using to look for overallocations? Please provide a screen shot.

    If you look at the Resource Usage view at master level or at resource pool level, you should see resource overallocations across all shared projects. Keep in mind that overallocation may only be applicable to one file depending on how the resource's work is allocated over each assignment and the leveling option basis (i.e. hour by hour, day by day, etc.)



    Also, what version of Project are you using?

    John

    • naetroze's avatar
      naetroze
      Copper Contributor

      John-project Tnx for asking.
      Using assign resources and resource pool enables to see over allocation and resource leveling, between master project and the sub projects.
      But I can't see the over allocation between the sub projects



      • John-project's avatar
        John-project
        Silver Contributor
        naetroze,
        Here's what I want to see:
        1. Screen shot of your leveling options
        2. Resource Sheet
        3. Master file Resource Usage view with these Details
        a. Work
        b. Work availability
        c. % Allocation

        John
