Forum Discussion

Jerome_Teoh's avatar
Jerome_Teoh
Copper Contributor
Dec 20, 2022

Question marks in the duration?

Hi,



I am wondering why I always have question mark on the duration?





Thanks,

Jerome.



3 Replies

  • Jerome --

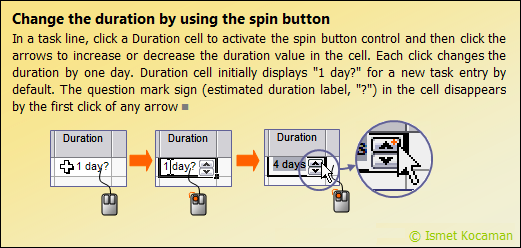

    In addition to the excellent answer by my colleague, Tony, I wanted to let you know WHY Microsoft Project is displaying the question mark for tasks in the Duration column. The question mark symbol with the Duration value indicates that the Duration is an "estimated" Duration, which means that it is the default Duration value entered by Microsoft Project. When you manually enter a Duration value, then the question mark will disappear.

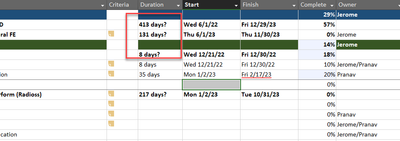

    A best practice I recommend is to look for tasks that have the question mark displayed in the Duration column, as these represent tasks for which you have not yet entered a Duration value. Before your project goes live, NO task should display question mark in the Duration column. In a very large project, it can be quite a challenge to find every task that still has a question mark displayed in the Duration column. To help with this, you can apply the built-in Tasks with Estimated Durations filter in the More Filters dialog.

    Hope this additional information helps.
  • ismet_kocaman's avatar
    ismet_kocaman
    Brass Contributor

    Jerome_Teoh

    Pls see this support article: https://support.microsoft.com/en-us/office/estimated-task-field-d5bd2410-9e1e-428f-bdb3-806cd2d8beff



  • TonyProctor's avatar
    TonyProctor
    Brass Contributor

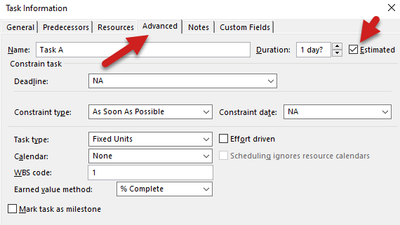

    Jerome_Teoh great question. If you double click the task, go to the "Advanced" tab and uncheck the "Estimated" checkbox then it will go away.

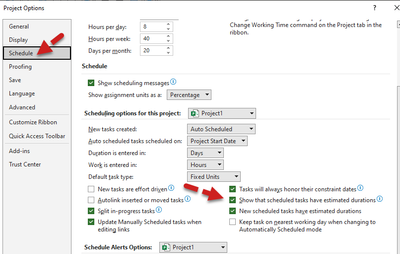

    **Tip: If you go to the "File" tab, Options (at the bottom), click the "Schedule" link on the left and then uncheck the "Show that scheduled tasks have estimated durations". This will remove it in the ENTIRE schedule ; )

    Let me know if that resolves it for you.
