Project Online: Error when accessing a newly created PWA instance

Hi,

I just created a new PWA site for my client's office 365 tenant (via Sharepoint Admin Center > Active Sites). I chose Create Site > Other Options > Choose a template "Project Web App site". I made myself the administrator of this site.

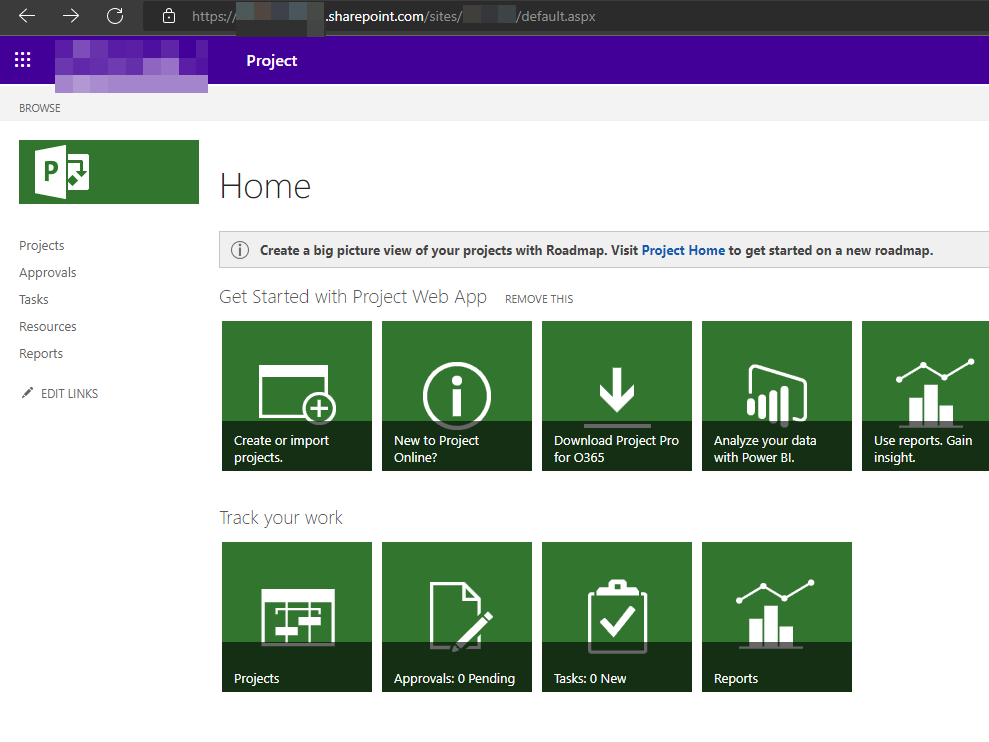

After the site was created, I accessed this PWA site and everything was ok at first.

Until a short moment after, I revisited the site again and it has shown this message



"No Project Web App instances found. Create at least one PWA instance before accessing this page."



I have created PWA before and never encountered this. Please advice.

Thank you.

  • Matthew Carter's avatar
    Matthew Carter
    Jul 05, 2022

    I just got off the phone with Microsoft support.

    Seemed that the GUI for setting this up didn't work and after running a command showed that PWA was disabled - PWAEnabled : Disabled

    We ran these in PowerShell (we changed the name here to YOUR tenant name, and YOUR site):
    Connect-SPOService -url https://M365TenantNameHere-admin.sharepoint.com
    Get-SPOSite -Identity https://M365TenantNameHere.sharepoint.com/sites/PWASiteNameHere |fl
    #PWAEnabled : Disabled
    Set-SPOSite -Enable $true -identity https://M365TenantNameHere.sharepoint.com/sites/PWASiteNameHere







    Now it works, I had a few sites that I created, so we ran the command a few times.  This is what it should be.  Seems when it was going through, it somehow changed the PWAEnabled: Disabled when it should be Enabled.  The graphic above shows when we executed and got the result below and checked and it was enabled.  Originally it was disabled.



6 Replies

    • Matthew Carter's avatar
      Matthew Carter
      Iron Contributor

      I just got off the phone with Microsoft support.

      Seemed that the GUI for setting this up didn't work and after running a command showed that PWA was disabled - PWAEnabled : Disabled

      We ran these in PowerShell (we changed the name here to YOUR tenant name, and YOUR site):
      Connect-SPOService -url https://M365TenantNameHere-admin.sharepoint.com
      Get-SPOSite -Identity https://M365TenantNameHere.sharepoint.com/sites/PWASiteNameHere |fl
      #PWAEnabled : Disabled
      Set-SPOSite -Enable $true -identity https://M365TenantNameHere.sharepoint.com/sites/PWASiteNameHere







      Now it works, I had a few sites that I created, so we ran the command a few times.  This is what it should be.  Seems when it was going through, it somehow changed the PWAEnabled: Disabled when it should be Enabled.  The graphic above shows when we executed and got the result below and checked and it was enabled.  Originally it was disabled.



      • Dolly1695's avatar
        Dolly1695
        Copper Contributor

        Hello! It seems like you're experiencing an issue where your newly created Project Web App (PWA) site in SharePoint isn't recognizing the PWA instance. This can be due to a few reasons, such as configuration issues or delays in service setup. Here are some steps you can take to troubleshoot and resolve this issue: Verify PWA Instance Creation: Ensure that the PWA instance was fully created and is linked properly to the site collection. Sometimes the setup might take longer than expected, so it’s also worth waiting a little and then checking again. Permissions Check: Double-check that you have the necessary permissions to view and manage the PWA instance. Even though you've made yourself the administrator, confirm that all permission levels are correctly set up. Create a PWA Instance: If there truly is no PWA instance (it might not have been created due to an error), you will need to create one. Here’s how you can do it: Go to the SharePoint Admin Center. Navigate to "More featureshttps://birdfeederworld.com/finch-feeder/ at the bottom of the left-hand pane. Under "Project settings", click on "Open". Here, you can create a new PWA instance. Make sure to link it to the correct site collection. Check Service Health: Sometimes, issues like these can be caused by problems on Microsoft’s end. Check the Office 365 Service Health dashboard to see if there are any advisories or incidents that might be affecting the service. Revisit SharePoint Admin Settings: Revisit the settings where you initially set up the PWA site. There might be configuration options or additional setup steps that were overlooked. Use Microsoft Support: If the problem persists, consider raising a support ticket with Microsoft. Since this involves backend functionalities that typical administrators might not have access to, Microsoft support could provide a more direct solution. Documentation and Community Forums: Look through Microsoft's official documentation for any known issues or setup peculiarities with PWA on SharePoint Online. You can also check community forums such as Tech Community or Stack Exchange for advice from other users who might have faced similar issues. By following these steps, you should be able to resolve the issue of not being able to access the PWA instance on your SharePoint site. If all else fails, professional support from Microsoft is the best next step.

  • johnwhat's avatar
    johnwhat
    Copper Contributor

    To solve “No Project web app instances found” error, you should enable PWA Site feature for Project Web Instance by doing the following:

    Enable PWA Site Feature in Project Server 2016
    Steps
    Open SharePoint 2016 Management Studio as Administrator.
    Open SharePoint 2016 PowerShell - Upgrade and Migrate to Project Server 2016
    Enable ‘pwasite‘ feature on the newly created PWA site collection.
    Enable-SPFeature pwasite -URL http://PWAURL
    Enable PWA Feature PowerShell
    Make sure that the PWA site collection has a Project Template “pwa#0″ before enabling the PWA feature. Read more at Failed to find Project Site object. Are there any database mounted?

    Go back to browse the PWA 2016 Instance that should be now working properly.
    Open PWA 2016
    PWA 2016
    If you still getting “No Project web app instances found Create at least one PWA instance before accessing this page“, that means the PWA instance is not configured properly. In this case, it’s strongly recommended to check this guide to Install and Configure Project Server 2016 step by step to create a PWA 2016 instance in a proper way.

    Conclusion
    In conclusion, we have learned how to enable the PWA feature for PWA site collection to avoid “No Project web app instances found. Create at least one PWA instance before accessing this page” in Project Server 2016.

    Applies To
    Projecthttps://tupacofficial.com/Server 2016.
    Project Server 2013.
    You might also like to read
    Simply, What are new and deprecated features in Project Server 2016?
    Migrate to Project Server 2016 step by step.
    SharePoint Permission Mode Vs Project Server Permission Mode in Project Server 2013.
    Project Server 2016: SharePoint Permission Mode Vs Project Permission Mode.

    • drjawadjani's avatar
      drjawadjani
      Copper Contributor

      This issue usually occurs because of the PWA instance is not provisioned correctlyhttps://kanyewestclothing.com/ You didn't create the PWA Project Database. You created the PWA Project Database but you didn't attach it to your PWA instancehttps://bapehoodie.uk/
