Forum Discussion
Project Online - Business Drivers matrix table in Power BI
Hi!
After classifying our ongoing projects we could get to this matrix table in Project Online:
There are 6 Business Drivers where each project contributes on a rating scale (None, Low, Moderate, Strong, Extreme)
I am stuck on Power BI to find the relation between each Project, the rating scale and each Business Driver to be able to build the same matrix table in Power BI:
Any help would be much appreciated!
6 Replies
- WoodyBrass Contributor
Many thanks!
With step 2, I merged as New table PortfolioAnalysisProjects with PortfolioAnalysis on AnalysisId and I kept the following columns (PrioritizationId column does not exist yet):
ProjectId
ProjectName
AnalysisId
AbsolutePriority
AnalysisName
Priority

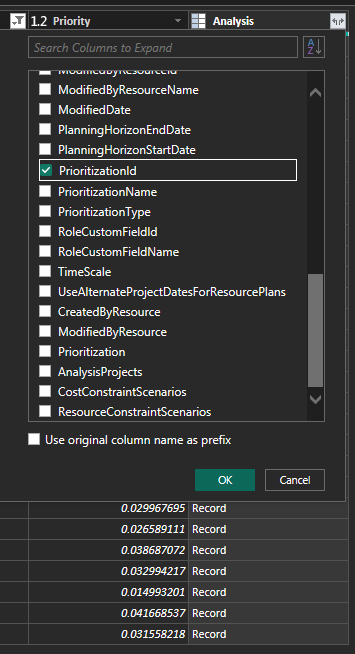

Analysys (Record)I can see PrioritizationId is in the Analysys (Record) column:

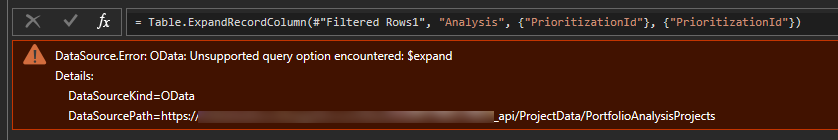

But when trying to expand only for PrioritizationId this is the error I get:So I cannot continue to merge with PrioritizationDrivers on PrioritizationId.
- RodFrommSteel Contributor
Try this and see if you can extract the PrioritizationId from the Analysis record. I don't have this functionality enable in my PWA so you may have to fiddle with it a bit to make it work.Steps to Create and Use the fxGetPrioritizationIdByAnalysisId Function
- Create the Function Query
- In Power Query, create a new blank query.
- Name it fxGetPrioritizationIdByAnalysisId.
- Add the Function Code
- Copy and paste the provided code into the fxGetPrioritizationIdByAnalysisId query.
- Apply the Function in Your Data
- Go to the PortfolioAnalysisProjects query.
- Click Add Column > Invoke Custom Function.
- Configure the Function Invocation
- Set the new column name to: PrioritizationID.
- Choose the function query: fxGetPrioritizationIdByAnalysisId.
- For the parameter, select the AnalysisId column.
- Finish
- Click OK to apply the function and generate the new column
let GetSelectedFieldsFromAnalysis = (analysisId as text) => let url = "https://<your PWA URL>/_api/ProjectData/PortfolioAnalysisProjects('" & analysisId & "')/Analysis", result = OData.Feed(url, null, [Implementation = "2.0"]), record = result{0}, selectedFields = Record.SelectFields(record, {"PrioritizationID", "AnalysisName", "CreatedDate"}) // Add more fields as needed in selectedFields in GetSelectedFieldsFromAnalysis- WoodyBrass Contributor
The function worked like this, taking into account there is only one analysis done, so all projects have the same AnalysisId:
let GetSelectedFieldsForEachProject = (ProjectId as text) => let url = "https://mycompany.sharepoint.com/sites/pwa/_api/ProjectData/PortfolioAnalysisProjects(AnalysisId=guid'4734f66d-b33f-f011-b02b-00155d7c9042',ProjectId=guid'" & ProjectId & "')/Analysis", result = OData.Feed(url, null, [Implementation = "2.0"]), selectedFields = Record.SelectFields(result, {"PrioritizationId", "AnalysisName", "CreatedDate"}) in selectedFields in GetSelectedFieldsForEachProjectThe following are the five tables with all private company data removed:
https://1drv.ms/x/c/82e81f538612a159/EYUzGHmjzQJOiIh0tmXiKe4BeclO5873PXywIFOjFGiu6A?e=jC61bVhttps://1drv.ms/x/c/82e81f538612a159/ES6U63BJnkxDoFQ22oCEagwB3MHHGqULpasnd59HM06zVQ?e=lk4wEm
https://1drv.ms/x/c/82e81f538612a159/EXsY3tuEL6NHhgwl2q1yJTkBmwwSdA9LhHHiaPCtmF1ndw?e=v1bWUK
https://1drv.ms/x/c/82e81f538612a159/EVreqh2jAw1Jp6f3KpcUUj4BKkknPJq-g3NmUZ2H6fVTmg?e=4g5Lmx
https://1drv.ms/x/c/82e81f538612a159/ETiSJCziIPVPnk_owthsW3gB_j5JNgXiebng5t_c7HWFUA?e=YcY60f
I am not able to find the relationship between each Project, the Impact Level and the Business Driver to create that matrix table. I believe there is no connection.
- Create the Function Query
- RodFrommSteel Contributor
Here is my take on this given the limited info I have about your model and other requirements. If nothing else this may give you some ideas on how to accomplish your end goal.

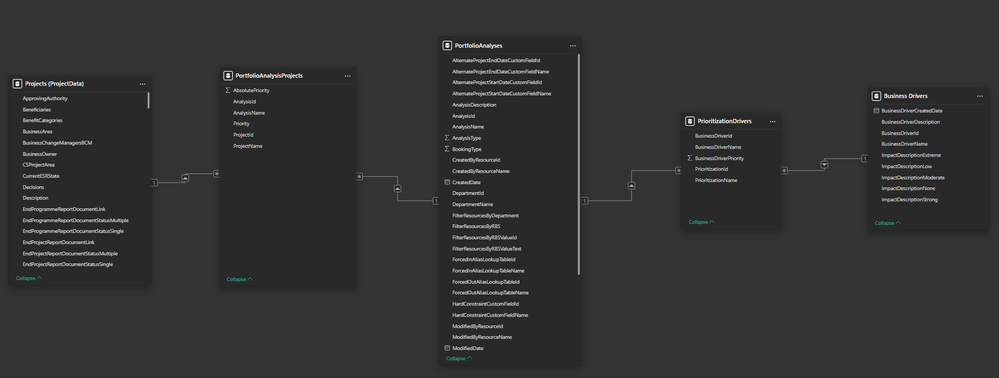

I would build a new table in Power Query as follows.- Load All Tables:
- Project
- PortfolioAnalysisProject
- PortfolioAnalysis
- PrioritizationDriver
- BusinessDriver
- Merge Queries:
- Start with Project
- Merge as New table with PortfolioAnalysisProject on ProjectId
- Merge with PortfolioAnalysis on AnalysisId
- Merge with PrioritizationDriver on PrioritizationId
- Merge with BusinessDriver on BusinessDriverId
- Select and Keep Only:
- Project[ProjectName]
- BusinessDriver[DriverName] (A–F)
- PrioritizationDriver[DriverValue] (None–Extreme)
- Name new table BuinessDriverMatrix?? and establish relationship to Project table
- Pivot the Table:
- Select DriverName column → Pivot Column
- Use DriverValue as the Values Column
- In the pivot settings, choose Don’t Aggregate (or use “Max” if needed)
- Load All Tables:
