Forum Discussion
How to customise su project group font style
I have a file with several project and I use it as synthesis of my work.
I’m able to customise font style for group of actions but I don’t see how to manage subproject title.
what I’m missing?
thank you
Formatting rules are different for linked structures such as a master with subprojects. The summary line insertion points, (e.g. "Subproject1"), are ignored as summary lines when using Format > Text styles. However you can use this trick. In the master, set the Marked field to "yes" for all summary lines, including subproject summary line insertion points. Then set the desired font color and style for Marked fields using Format > Text styles. This will even allow you to set the font color and style of the Project Summary Task in the master.
John
8 Replies
- John-projectSilver ContributorDariocg,
When you say, "file with several project(s)", what exactly do you mean? Do you mean you have a dynamic master with several inserted subprojects?
What exactly do you mean by, "customize font style for group of actions"? What group of actions?
When you say, "subproject title", what exactly do you mean? Perhaps a screen shot would help.
Bear in mind that inserted subprojects are not actually part of a master file, rather, the master only contains pointers to each individual subproject file. Any formatting you do at master level is restricted to the master and has no effect on the formatting of the separate subproject files.
John- DariocgTin Contributor
Sorry for wrong terms... I have to install English version
I have have a dynamic master with several inserted subprojects.
I'm not able to customise these titles (I.e. "Subproject1") from Format >Text style
When I say subproject title I mean the main row of a subproject in a master, the title of a subproject.
For group of actions I meant "summary tasks"
Thanks
- John-projectSilver Contributor

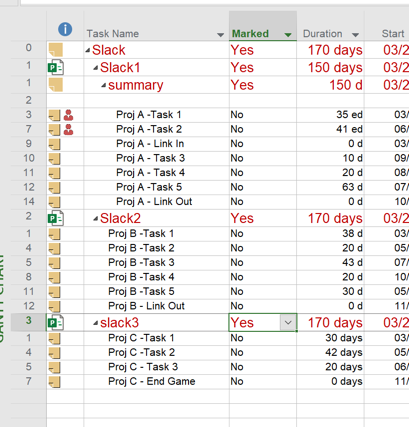

Formatting rules are different for linked structures such as a master with subprojects. The summary line insertion points, (e.g. "Subproject1"), are ignored as summary lines when using Format > Text styles. However you can use this trick. In the master, set the Marked field to "yes" for all summary lines, including subproject summary line insertion points. Then set the desired font color and style for Marked fields using Format > Text styles. This will even allow you to set the font color and style of the Project Summary Task in the master.
John
