Forum Discussion

TulioOliveira's avatar
TulioOliveira
Copper Contributor
Dec 18, 2024

Extract Data with VBA in the Project

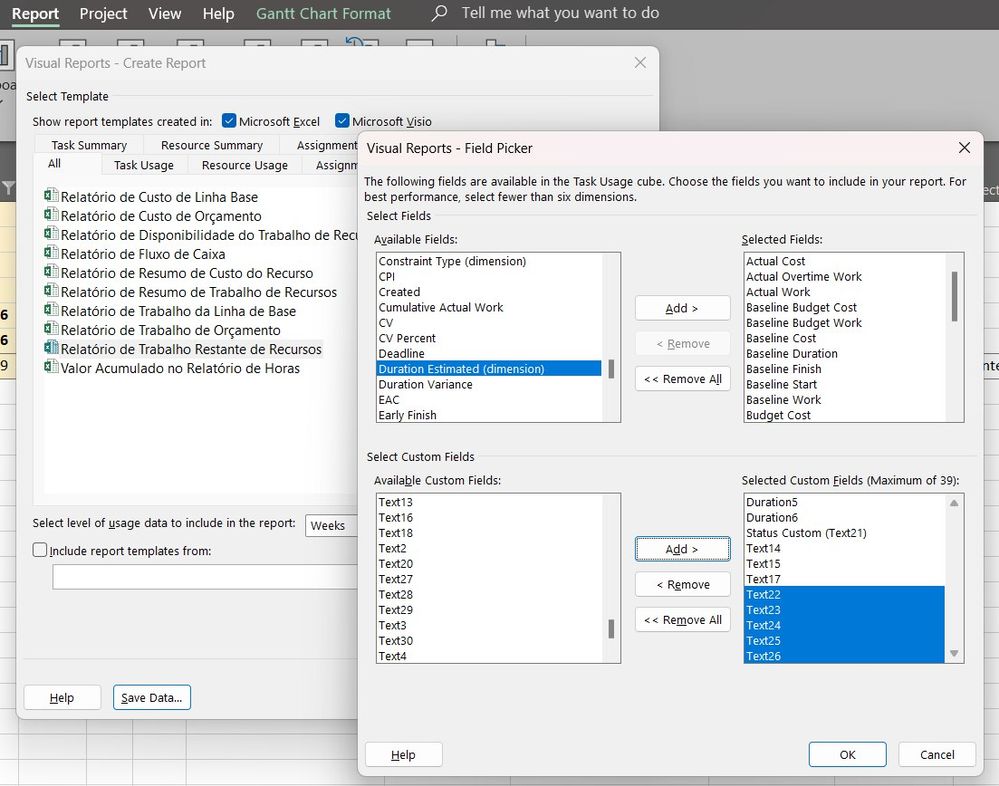

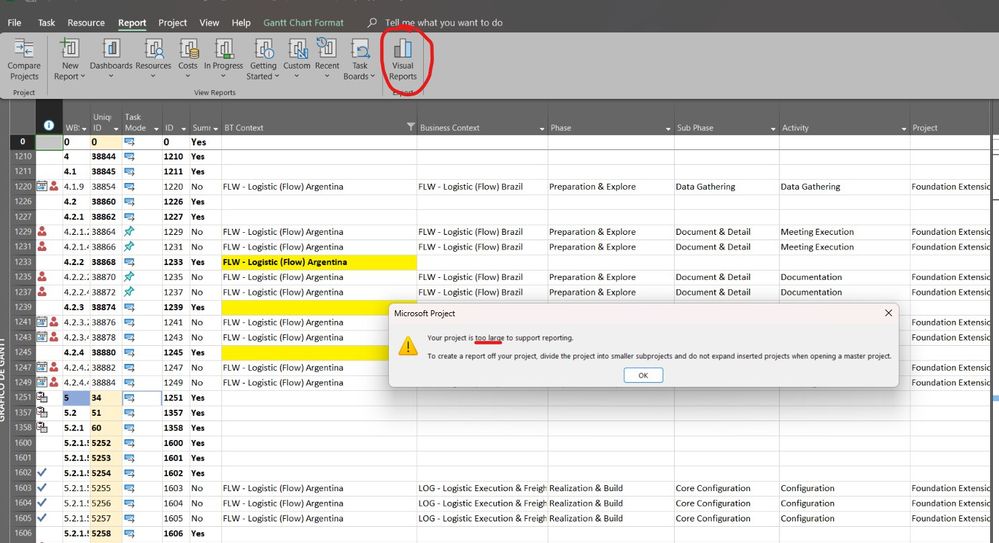

Hi guys, I need some help.I need to extract data from the project to connect to Power BI. I'm currently using the feature in the database model by going to Report>Visual Report>Save Data Select: Task SummaryField Picker (for custom fields) Save Database However, the chronogram is too large and I'm getting an error on this screen asking me to reduce/separate the project. I wanted to do this export in VBA, I even tried using the VBA code below, but I couldn't find a parameter to export the custom fields.

Sub Macro1()

VisualReportsSaveDatabase  strNamePath:="C:\Users\tulio.oliveira\Downloads\Chronogram_Consolidated_V5.mdb", PjVisualReportsDataLevel:=pjLevelWeeks

End Sub





8 Replies

  • Hi Tulio.

    Custom fields in Ms Project are constant over time, they always have the same unique value assigned throughout the project for the task or resource, so you don't need to granulate anything.
    If what you need is to export those 7 custom fields, you just need to include them in the task table columns and copy and paste into Excel, or if you prefer you can do an export to Excel via Save As with the xls file type, which are almost immediate procedures.
    Only if you need to manage cost field information or resource work hours in different periods, the granular data you refer to makes sense, but not for custom fields, or any other type, other than cost or work, except for some fairly rare small exceptions.

    Ignacio

  • Hi Tulio.

    Considering that Access has a database size limitation of approximately 2 GB, it is very likely that you will not be able to export projects over a certain duration and with multiple tasks.

    Depending on the information you want to obtain, you could look for an appropriate solution.

    There are Project fields that are time-phased (byday) and many others (most) that are not, such as custom fields, which would be easily exportable.

    Ignacio

  • Hi Tulio.

    By way of visual reports, I don't think it's possible to export custom fields, not even by saving the database, at least I never managed to do it after many attempts, even though it's shown as an eligible option.

    In a quick way, you can copy and paste the task table into Excel: Select the entire table with Ctrl+Shift+Space, or click on the top left corner of the table, and then Ctrl+C to copy and paste into an Excel sheet later. Obviously the custom fields must be included in the Project task table.

    Another option is to export the selected fields to Excel, including the custom ones, through the Wizard that is shown in Save As, choosing Type Excel Workbook...

    You can also create a simple macro (VBA) that exports fields, including the custom fields. There are many examples on the Internet.

    In any of these options, you should not have limitations on the size of the data to export, unless it is an immensely large file, which does not seem to be the case that you show, or you have limitations on your devices.

    I hope this information helps you.

    Ignacio

    • TulioOliveira's avatar
      TulioOliveira
      Copper Contributor

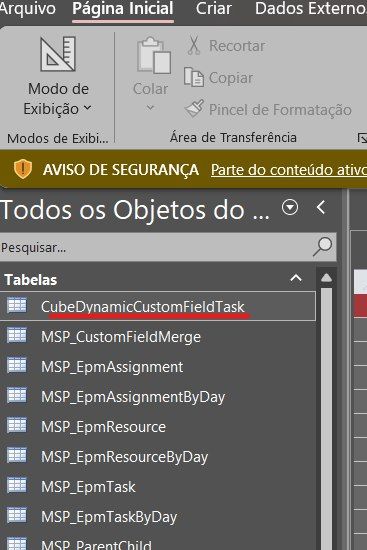

      Thanks Ignacio_Martin, but this way it wouldn't help me copying (CTRL + C) and pasting into Excel. As I said before, I'm doing the extraction in a structured way by exporting to an Access database model available within Project. It already brings me all the structured tables, including some tables with granularity (days, weeks, months). However, as the schedule grows, it no longer allows exporting. I tried using VBA, but the method I used didn't export the "CubeDynamicCustomFieldTask" table, which is responsible for the custom fields.

      In addition, the export of the MSP_EpmTaskByDay table already exceeds 1 million rows due to the weekly granularity.

      • John-project's avatar
        John-project
        Silver Contributor

        TulioOliveira,

        You can export any type of Project data to Excel (or Access) with VBA but it would have to be per task, resource and/or assignment instead of "en-masse" as a cube. I've written many macros that export all kinds of Project data to Excel.



        Just curious, what Project fields are you trying to export?

        John
