"Deadlines" to start by
Deadlines are useful, since they do not shift when the project is recalculated.
Is there a way to set a "deadline" that indicates - "must start by", instead of "must be completed by"?
(I guess I could set a sacrificial milestone before the relevant task with a deadline)
6 Replies
- Ignacio_MartinSteel Contributor
You can try the Schedule from: Project Start Date option in Project / Properties / Project Information, and Project will calculate a Start date from a Finish date, based on the current schedule.
Regards
- John-projectSilver ContributorIgnacio_Martin,
I think you have a typo. I think you meant to say, Schedule from: Project Finish Date.
Unfortunately, although reverse scheduling may sound like a good idea to users who want to "nail down" the plan's finish, it generally results in a lot of confusion and unexpected scheduling.
John- Ignacio_MartinSteel Contributor
"My apologies and thanks to John for detecting that typo error"
"The correct procedure to schedule backward from the Project Finish Date is as follows: go to Project / Properties / Project Information, and Project will calculate a Start date from a Finish date, based on the current schedule.
Although this option is not usually recommended, it can be useful for simulations such as 'When should I start if I want to finish on a certain date?' Later, the result can be used as a starting point for a new or adjusted schedule of the existing one"
Hello Yaakov_Shaked ,
You can use a new custom Start field and add that to the Gantt - rename the field as needed:

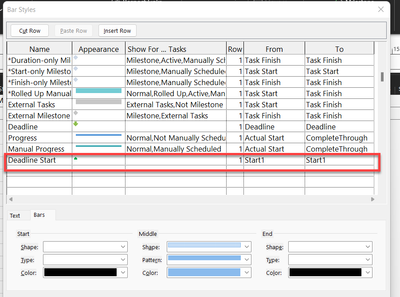

Right click on the Gantt then click Bar Styles and add the new bar style, example below:
Hope that helps
Paul
