Forum Discussion

Thetravis12's avatar
Thetravis12
Brass Contributor
Aug 28, 2023
Solved

Bar Styles with Rolled Up Tasks

I would like to create a bar style to format rolled up tasks. I want three different styles. I want a style to be used when a task is Rolled Up and when Flag 1 is active, a different style to be used when a task is Rolled Up and Flag 2 is active, and a third style to be used when a task is Rolled up and Flag 3 is active. I have removed all other styles that are not in use in my Gantt chart. No matter what I do, as soon as I add any other condition to the bar style besides "Rolled Up", all symbols in the "Rolled Up" task line disappear. In the attached screensnip, all rolled up tasks appear with the blue pentagon, regardless of whether other flags are active or not. As soon as I type "Flag 1" after "Rolled Up" in the "Show For... Tasks" column, all symbols disappear for rolled up tasks, regardless of which flags are active. I have tried creating unique flags, to be used exclusively for rolled up tasks. I have tried activating the flags before creating the bar style, and I have tried activating the flags after creating the bar style. No matter what I do, I cannot create more than 1 bar style to govern the appearance of rolled up, recurring tasks. What am I doing wrong?

  • Thetravis12

    Thanks for the file. I didn't know you could attach a zipped file. Previously if needed to see someone's file I'd ask them to send me their file via e-mail. So, I learned something new.



    This issue is that none of the subtasks under the summary lines have any Flag fields set. Just setting the Rollup field to "yes" at summary level does NOT create the display you want. There has to be something to "roll up". I showed that in my first response but I guess I didn't highlight it.



    I tweaked your file so it's something easier to see. I eliminated the summary level "blue house" bar style so it doesn't get in the way and then set the Flag fields. I had to toggle the "Rollup" field at each summary level from "yes" to "no" and then back to "yes" to get things "re-ordered" (I suspect your poor file is so confused that it needed a little reset). Anyway, this is what you'll have. I think it is what you want.

    If that is not what you want you'll have to give me a better explanation. I know it's all real clear in you head as to what you want but I'm not in your head.



    John

12 Replies

  • John-project's avatar
    John-project
    Silver Contributor

    Thetravis12

    I looked at your screen shot and read your scenario and I don't quite understand what you're saying. But, this is what I get when I implement rolled up bar styles with Flag fields.

    What version of Project are you using?

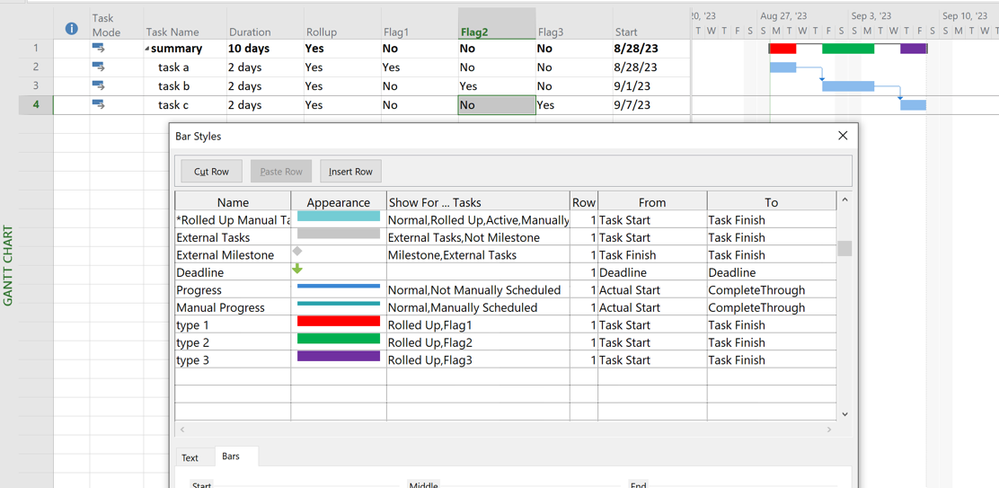

    It's important to understand that bar styles at the bottom of the list take precedence over potentially conflicting bar styles toward the top of the list. In your screen shot I see only 1 bar style with rollup criteria so even though it is at the top of the list, it will be the only rollup style available.



    John

    • Thetravis12's avatar
      Thetravis12
      Brass Contributor

      John-project

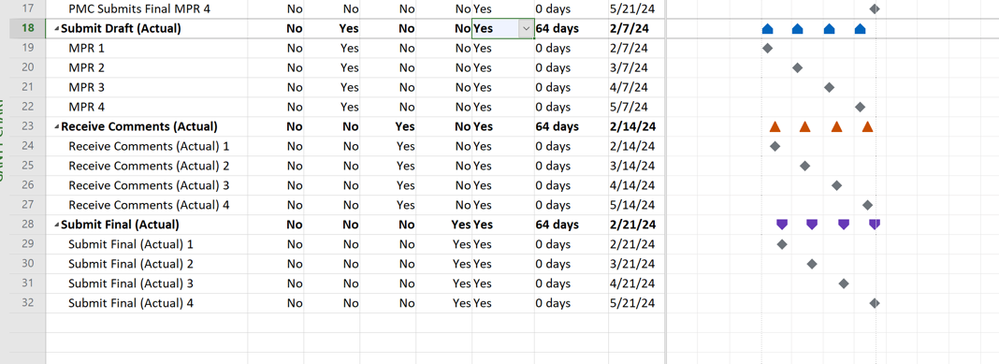

      Hi John; thank you for your quick reply. I've attached a screenshot of the behavior I want to see. Each of these rows represents a rolled-up, recurring task, with 0 duration, where the bar style is formatted as from Task Finish to Task Finish. In actuality, because I could not get the bar styles to work as desired, I created this by formatting each symbol individually, which is quite tedious for a task that recurs monthly over many years. I've attached another screenshot in which I've included another bar style for a rolled up task with Flag 4 active. You'll notice that the blue pentagon is still shown in the last row, while the desired orange triangle is not shown.
      The information regarding precedence is very helpful - I was not aware of that. However, it appears that what actually happens is that both symbols are printed, but the lowest symbol in the bar styles list is printed on top of the other symbol(s). I've attached another screenshot indicating this behavior.
      The version of project is Version 2307 (Build 16626.20170 Click-to-Run). The product is Microsoft project Standard 2016.

      Thanks

      • John-project's avatar
        John-project
        Silver Contributor
        TheTravis12,
        Sorry but I don't see any difference between "desired appearance" and "actual appearance" with respect to what I assume are the three summary levels.

        What exactly are the summary lines at the top? It would help to see the hierarchy along with the Flag fields and the Gantt display.

        Yes, you are correct about the overwriting. That's why you need to be careful in setting up bar styles.
        John
