Automate bars based on task name?

Hey all, hoping someone can help me with this, or confirm or not whether it's possible!



So in MS Project, I'm looking to automate some custom progress bars that I have created, and I would like to have it automated based on the task title, for example:

Task Title - "Development" - Green bar

Task Title - "Commissioning" - Blue bar with gradient

Task Title - "Go Live" - Green triangle icon



Right now what I have set up is about 7 or 8 different custom bars that are linked to "flags", which allow the progress bars to be added by selecting "yes/no" in the appropriate column. This is fine for the moment, but surely there's a smarter way to go about this? I guess I'm looking for conditional formatting in a way? šŸ¤”

6 Replies

  • John-project's avatar
    John-project
    Silver Contributor

    chrisbloggs1300

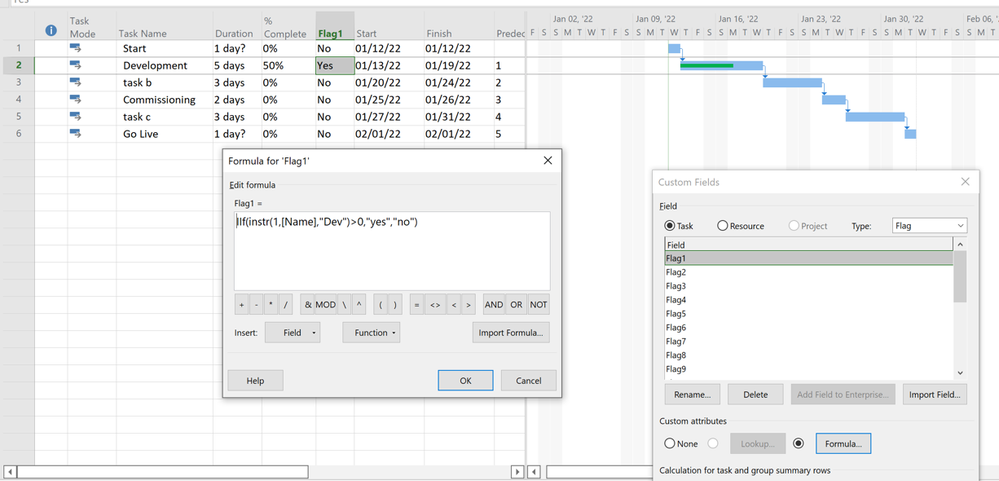

    You're halfway there. All you need to do is to customize each flag field with a formula such as shown below. But be careful, testing for text strings can be tricky (i.e. misspelling, capitalization, etc.)

    John

    • chrisbloggs1300's avatar
      chrisbloggs1300
      Copper Contributor

      John-project thank you for the informative response John, really appreciate it!

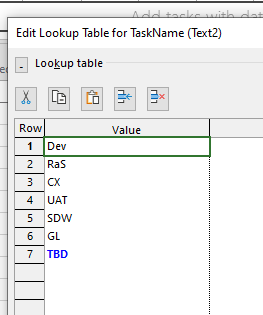

      So what I've done is with the help of the lookup table function under the "text" field type is create these values based on the tasks:

      It then becomes a dropdown, which based on the formula - [Text2]="*Text2 Name I created*", will autofill based on these flags which I have set up with the existing progress bars:

      This works infinitely better than scrolling through 7/8 columns and lining up "yes/no" for each, but I'm still wondering if I can automate it just that little bit more...could I create an "if" statement for the "TaskName" column which looks at the actual task name field and auto-populates the "TaskName" column based on what it reads? E.g. =IF(A1=ā€Developmentā€,Dev,"")...something along those lines! But then at the same time, I suppose I'm also looking at combining lookup with the formula field, which I imagine isn't possible?



      Sorry for the essay! Throwing my thoughts in there wherever I can, aha!





      • John-project's avatar
        John-project
        Silver Contributor

        chrisbloggs1300

        Ouch! Stop! You're throwing your thoughts at me too fast!



        Yes you can create a custom field formula to query the text string in the Name field and dump it in abbreviated version into your Text2 field and then use that to drive your Flag fields, but why? I must be missing something.



        What you cannot do is to have a single custom field that has both a lookup and a custom field formula.



        If I had a clearer understanding of exactly what you are trying to do I could help more, either with custom fields or VBA, but right now, it's kinda a fog.

        John

  • Chris --

    The way you are approaching this situation is how I would handle the custom formatting of the Gantt Chart pane. The best way is to use custom Flag fields to identify what type of Gantt bar to display for specific tasks in your project schedule. Just a thought. Hope this helps.
