Forum Discussion
Why aren't some Tasks displaying Custom Field Graphical Indicators
- Jul 13, 2022
Actually I changed my test criteria to be as shown below and now all of the rows are reflecting a graphical indicator. So it was something related to how my test criteria were defined.
John,
Try this, switch your custom field "data to display" from graphical indicators to "data". You may find the "data" shows #ERROR. If so, resolve that problem. However, if the data seems correct, what is the formula in your custom field?
John

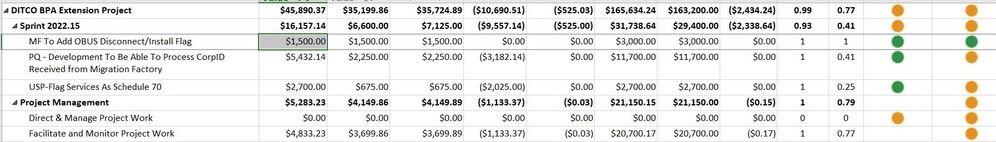

John-project The formula is simple. For cost KPI formula = CPI. For Schedule KPI, formula = SPI. When I changed the display from graphical indicator to data. There was no error. The CPI value displayed.
- John-projectJul 12, 2022Silver Contributor
John,
I notice the custom field for your Schedule KPI shows indicators for all task lines but the custom field for Cost KPI is missing indicators for a summary line and a task line. What are the custom fields for each (e.g. TextX, NumberX, etc.)?
Try changing to a different custom field for the Cost KPI. Is the indicator still missing from those lines?
John- JBLT-77Jul 12, 2022Iron Contributor
John-project I'm using the Number2 for Cost KPI and Number3 for Schedule KPI. I deleted the cost kpi custom field and was going to try and use the Number4 field, but now I'm getting an error when I try to rename the custom field to "Cost KPI" saying that the field name already exists. Not sure how it can since I deleted it.
- JBLT-77Jul 12, 2022Iron Contributor

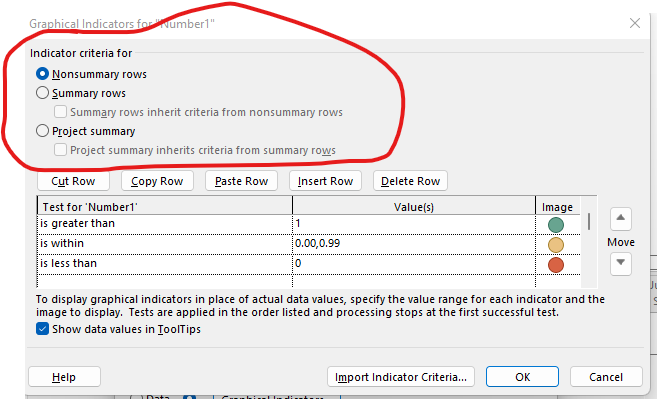

John-project I managed to get the graphical indicator field displaying on the project summary row by changing the options in the indicator criteria for.... to Project Summary. However, I tried doing the same thing by selecting to apply the options for Summary rows and non-summary rows, but I still have one non-summary task and a summary task not displaying a cost kpi graphical indicator. It's mind boggling.
