VIsual Basic and MS Project

Is it possible to develop in Visual Basic within the MS Project feature to report on a set of tasks a percentage of the status of tasks, for example, how many percent are completed, how much percent are late, etc?

  • Riele485

    Here ya go. This is the macro:

    Sub StatusMetrics()
    'macro written for Riele485 by John-Project 2/4/2022
    Dim t As Task, PS As Task
    Dim Cnt As Single, Comp As Single, Lat As Single, OT As Single, Fut As Single
    For Each t In ActiveProject.Tasks
    If Not t Is Nothing Then
    If t.Summary = False Then Cnt = Cnt + 1
    If t.Status = pjComplete Then Comp = Comp + 1
    If t.Status = pjLate Then Lat = Lat + 1
    If t.Status = pjOnSchedule Then OT = OT + 1
    If t.Status = pjFutureTask Then Fut = Fut + 1
    End If
    Next t
    Set PS = ActiveProject.ProjectSummaryTask
    PS.Text1 = Cnt
    PS.Text2 = Format(Comp / Cnt * 100, "##.0") & " %"
    PS.Text3 = Format(Lat / Cnt * 100, "##.0") & " %"
    PS.Text4 = Format(OT / Cnt * 100, "##.0") & " %"
    PS.Text5 = Format(Fut / Cnt * 100, "##.0") & " %"
    MsgBox "Total tasks: " & PS.Text1 & vbCr _
    & "Completed: " & PS.Text2 & vbCr _
    & "Late: " & PS.Text3 & vbCr _
    & "On Time: " & PS.Text4 & vbCr _
    & "Future: " & PS.Text5, Title:="Status Metrics"
    End Sub

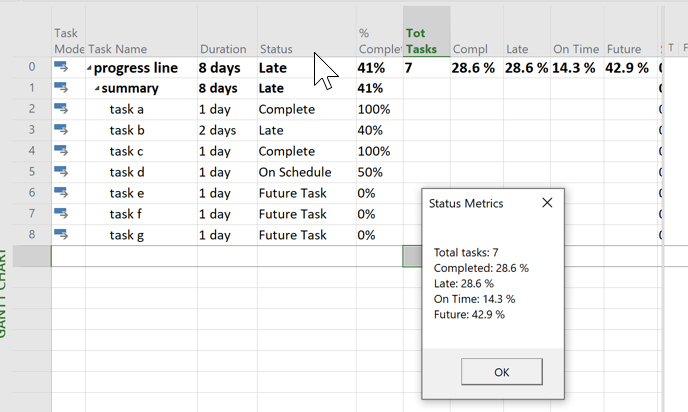

    And this is the result on a sample file:

    Pretty sweet huh?

    John

18 Replies

  • John-project's avatar
    John-project
    Silver Contributor
    Riele485,
    Yes. If you can provide more specific details about exactly what you want, I'll be happy to help you.
    John
    • Riele485's avatar
      Riele485
      Copper Contributor
      Without having to use Excel, develop macro in MS Project that informs me in the sets of tasks, percentage of each Task Status: completed, late, on time and future.
      • John-project's avatar
        John-project
        Silver Contributor
        Riele485,
        Sorry but that's not much in the way of specifics.
        1. Are you looking for a count of each type of status?
        2. Where would you like to see the data (e.g. Project Summary Task)?
        John
