Team Planner in MS Project Professional

Hi   I have a situation where I had a resource being overallocated on a particular day just by 0.13hr. Then I did a resource leveling and nothing happened still shows red man icon. (Resource leveli...
  • John-project's avatar
    John-project
    Jan 24, 2022
    kish27,

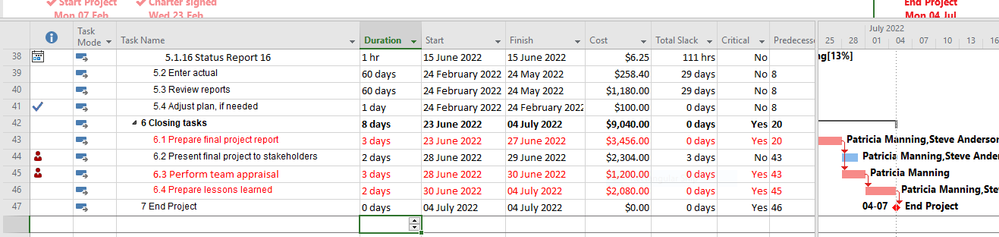

    Taking a quick look at your screen shot it looks like task 44 has no successor and that's probably why it is not on the critical path. In a good plan every task should have a predecessor, with a few exceptions, but every task MUST have a successor, even if it's the final milestone.
    John
