Forum Discussion
PrzywaraL
Nov 07, 2023Copper Contributor

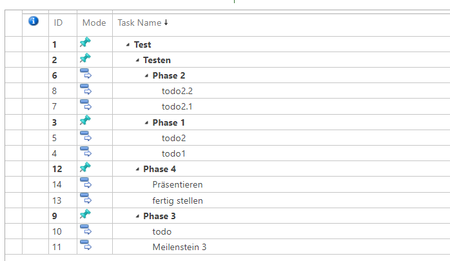

Tasks are not visible while trying to link to risks MS Project
I created a project with different tasks, as you can see in the SS. After that I created a risk. You can see the risk in the second SS. When I tried to link the risk to a task, no task where found. ...
- Nov 13, 2023
Hello PrzywaraL ,
Since making the sync tasks to Project site feature active, have you republished the projects? They will not appear in the Task lists on the Project Sites until the project/s have been published again.
Paul
PrzywaraL
Nov 13, 2023Copper Contributor
Thank you for your answer,
i already published my schedule and its also connected. I can see it in my Project Center
Thank you, The inactive Task feature, is a good help, but can I also connected it then to the risks?
The sync was not active, I activated it, but it still doesnt work
Nov 13, 2023
PrzywaraL --
To answer your question, I believe that a task must be Active so that it can be connected to a Risk. Hope this helps.
To answer your question, I believe that a task must be Active so that it can be connected to a Risk. Hope this helps.
- PrzywaraLNov 13, 2023Copper Contributor@Dale
Yes, it has to be active, thank you. Do you have some tips, how to use the risk feature? I saw your Video with the inactive task. This is a good way to plan the project with risks, but then i dont need the risk feature right?
