Forum Discussion

Luca_60's avatar
Luca_60
Copper Contributor
Jan 23, 2024
Solved

Sub project management problem

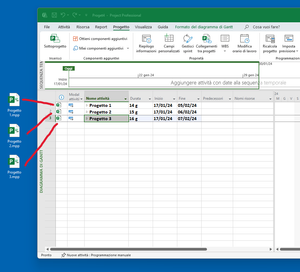

Hi community - I have three files with three projects, saved respectively "project 1", "project 2" and "project 3" - Starting from an empty document I go to the Project > Subproject tab and insert...
  • Dale_HowardMVP's avatar
    Jan 23, 2024
    Luca_60 --

    You are renaming your subprojects in the WRONG location. Open each of your subprojects individually and then do the following:

    1. Click File > Info.
    2. In the upper right corner of the Info page, click the Project Information pick list button and select the Advanced Properties item.
    3. In the Properties dialog, enter the name of the project in the Title field.
    4. Click the OK button, then save and close the subproject.

    After you complete the above steps for each of the subprojects, reopen your master project and you will see the correct names for each of your subprojects. By the way, this is NOT a bug. This is just how the software works with the naming of subprojects in a master project. Hope this helps.
