Forum Discussion
Shared Pool Resources are shown separately in Linked Project
- Jan 13, 2022Reuben,
For what you want to do, yes, you should open the resource pool file and then save all when you close out.
John

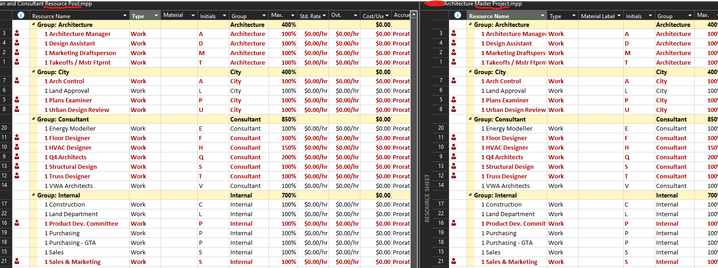

Here is a snip of the Resource Pool and the Master Project showing the same resources when viewed grouped by Resource Group. If I change the name of a resource in the Pool file it will change in the Master Project so I know they are synced. It also shows the same overallocation amounts.
I don't know why but it seems to be working now. It only shows 1 of each Resource after playing with the groups and filters and going back and forth from reports.
It now groups all the projects under each resource in the 'Team Planner' view like I wanted:
I don't know how I fixed this.
For context, this is how it used to show that resource split between the projects instead of grouped together:
Again, I am not clear on how I changed this......
The screen shot you posted earlier this morning of the Resource Usage view in the master file indicates resources are coming from each subproject, not from the pool. I can't tell what you might have done such that it now works but you gave the correct answers to my questions so I think you are on the right path. But, I'll give you one more thought. When working with linked structures in Project, you can never rename, move, overwrite, or save off to another location any of the files in the structure. Ideally all files should be in a single folder on a local drive and not be operated over a network.
John
- ReubenJan 13, 2022Iron Contributor
John-project I figured out why it was showing the resources separately but it did create another question you may be able to answer.
I realized that when I open the project it asks me if I want to open the Shared Resources pool file. If I click 'No' then the Team Planner will show the resources seperately. If I click 'Yes' then the Team Planner will show the resources grouped together.
My question: Is it best practice to have the Resource Pool file open whenever working on files that are using it?
- John-projectJan 13, 2022Silver ContributorReuben,
For what you want to do, yes, you should open the resource pool file and then save all when you close out.
John
- ReubenJan 05, 2022Iron Contributor
John-project Thank you for the tip.

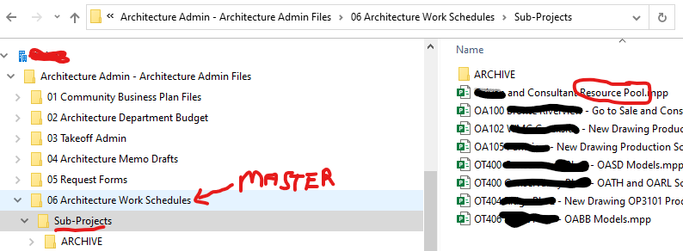

I have put all the sub-projects into a "Sub-Projects" folder along with the Resource Pool file.
The master project is in one folder level above.
Should the Resource Pool file be with the Master Project or the Sub-Projects folder?
Should the Master Project be in the same folder as the Master or the Sub-Projects?
Also, I am saving these in a synced Sharepoint Document Library. I don't know what that means for sharing these files since I am the only one working on them for now but I will cross that bridge when I get to it I guess. I assume you can not have multiple people editing mpp files like you can for Excel and Word.
- John-projectJan 05, 2022Silver ContributorRuben,
First of all I'd put all the files into a single folder. I see no advantage of separating the master and/or pool file from the subproject/sharer files.
Second, my understanding is that linked structures do not work on SharePoint, so I'd scrub that idea. Unlike Excel or Word, there can only be one instance of Project. I'd be real careful about multiple users editing any of the files in the structure unless they are fully trained on how to work with linked structures. My advice is to have one trained individual be responsible for all the files.
John- ReubenJan 05, 2022Iron ContributorOk good to know but it may be too late... Can I move them now or will that break the links?
I'll probably be the only one editing for a while. Ideally I'd like to figure out how to link the tasks in the project to show up in the Microsoft Planner app (if that is possible). Then the tasks can be assigned to specific users and ideally once checked off as complete by that user also automatically be marked 100% complete in the Project file. I'm not sure that is possible but it is my ideal process once I work out the kinks and get my schedules set up for the next 2 years of work.
