Relation between task duration, start, finish, and predecessors
Hello Everyone,
I'm creating a project and related tasks through ReST API. All tasks are created in auto schedule mode. Here is the summary task structure:

Now, when I change schedule mode to Manual, edit start date of 1st task and set predecessors for 2nd and 3rd sub-tasks, I get this result:
After applying predecessors, scheduling engine updates finish dates for 2nd and 3rd sub-tasks. Ideally if we look duration field values (in hours) for the these sub-tasks, finish date should remain same.
Does anyone knows what's going wrong or how to avoid this?
Thanks & Regards,
Rohan
5 Replies
Sort By
- John-projectSilver Contributor
There is something missing from your description. Apparently the 2nd, 3rd, and 4th subtasks have a start-no-earlier-than constraint because they have no driving (predecessor task) yet their start date is beyond the summary start date

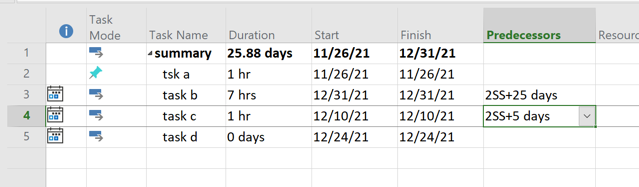

Setting up the scenario shown, this is what I get (same as what you show).
The only task that is changed to manual scheduling is the 1st subtask. Doing that and applying the task dependencies gives this result.
Everything is as expected
- rohanw24Copper Contributor
Hi John-project,
According to you what should I do or points I need to take care of while creating this summary tasks? Did I missed anything or done it incorrectly?
Thanks & Regards,
Rohan
- John-projectSilver Contributorrohanw24,
Well I don't know. Your screen shots only show a partial view of your plan. For example, I can't tell which column is represented by what field (i.e. ID, indicator, etc.). And the screen shot also does not show if the view is sorted or filtered or if the four tasks are the only subtasks under that summary line.
So the bottom line is, there is simply not enough information provided for me (or anyone else) to determine why you are getting what you show in your screen shots.
Just for reference, why would you want to change one of the subtasks to manual scheduling? In my view manual scheduling mode is not very useful except perhaps for creating a very rough starting point for a plan being developed.
John
