Forum Discussion

ashamrai's avatar
ashamrai
Copper Contributor
Oct 08, 2021

Project Server 2019 does not apply change of start date from requests

Steps to reproduce:

1. Create a request for a new task to the existing project.

2. Approve it and publish changes. Task in the project:

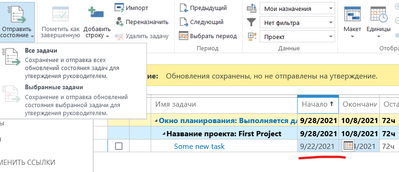

3. Create a new request to change the start date that is less than the current start date

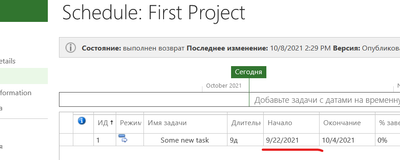

4. Approve it and publish changes. Changes are in the project:

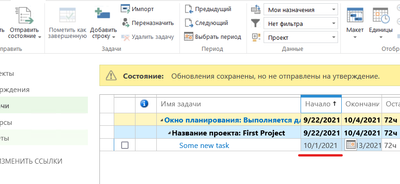

5. Create a new request to change the start date that is greater than the current start date

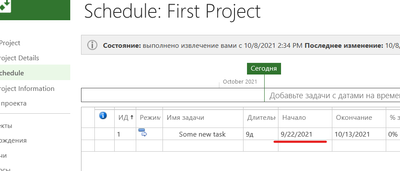

6. Approve it and publish changes. Changes are not in the project:

So project server does not apply changes of start date if the new date is greater than the current date.

No RepliesBe the first to reply
