Forum Discussion
Project Online Project Site - Adapt left hand navigation
- Feb 15, 2024
Paul_Mather Thanks for your reply. However, I knew we never solved this programmatically, so I searched for an alternative. Your hint concerning the provisioning process lead me to the answer.

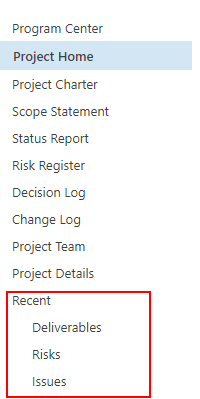

You need to activate the Project Web App Connectivity site feature beforehand on the site. Then the default Project lists are already created and the navigation entries are created. Now, you can delete the Navigation entries (or move them around) and save your template. During provisioning of new projects the new navigation will be kept.
This does not break the provisioning process (as long as you don't touch the lists themselves of course) and you can adapt the navigation without the process interfering.
Hello TamaraF ,
This is due to Project Online project site provisioning process creating the Risks, Issues and Deliverables lists on the site created event. You could either run a manual script to update the site nav post creation or build a remote event receiver solution that runs automatically after the site is created that goes and updates the site nav.
Paul
Paul_Mather Thanks for your reply. However, I knew we never solved this programmatically, so I searched for an alternative. Your hint concerning the provisioning process lead me to the answer.
You need to activate the Project Web App Connectivity site feature beforehand on the site. Then the default Project lists are already created and the navigation entries are created. Now, you can delete the Navigation entries (or move them around) and save your template. During provisioning of new projects the new navigation will be kept.
This does not break the provisioning process (as long as you don't touch the lists themselves of course) and you can adapt the navigation without the process interfering.
- Paul_MatherFeb 16, 2024MVP
Good catch TamaraF - I forgot about that as I've not touched Project Online for a while - most have moved away from it to Project for the web! I even documented about activating the feature here 10 years ago! https://pwmather.wordpress.com/2014/02/02/getting-started-with-projectonline-part-6-ps2013-office365-project-ppm-sharepointonline-pm-sp2013/
Paul
