Forum Discussion
susmatt
Dec 15, 2021Copper Contributor
Percent Complete in Bar Chart
Some of the bars will show the dark line through the middle for %complete and some will not. I went through the same steps on the purple bars as I did the blue bars and I can't get the %complete to s...
John-project
Jan 04, 2022Silver Contributor
Robert0842,
I don't quite understand what you are saying. Are you telling me you may think the purple bar is so dark that it hides the lighter progress bar so you can't see it? If not, what are you saying?
I asked to see a screen shot of your Bar Styles window as that could tell me a lot.
John
I don't quite understand what you are saying. Are you telling me you may think the purple bar is so dark that it hides the lighter progress bar so you can't see it? If not, what are you saying?
I asked to see a screen shot of your Bar Styles window as that could tell me a lot.
John
Robert0842
Jan 05, 2022Copper Contributor

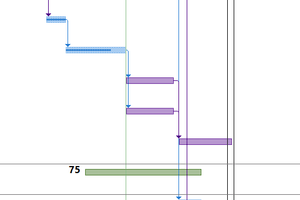

If the purple bar is placed under the progress bar in the Bar Styles dialog, it will mask the Progress bar.

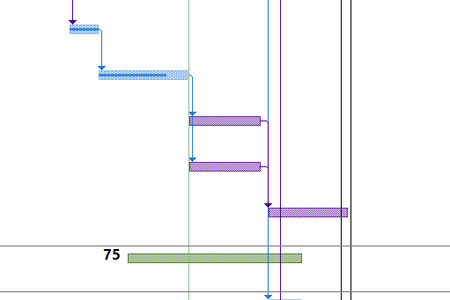

If the purple bar is placed above the Progess bar in the Bar styles dialog you will see both the purple bar and the progress bar:
Hope this help (sorry for my poor English)
- John-projectJan 05, 2022Silver ContributorRobert0842,
In Project bar styles lower in the list take precedence over bar styles higher in the list and that's exactly what you are seeing. That is also why in the default set of bar styles, the progress lines are the last two items in the list.
John
