New tasks have calendar 'None' - how to set a default calendar for new tasks?

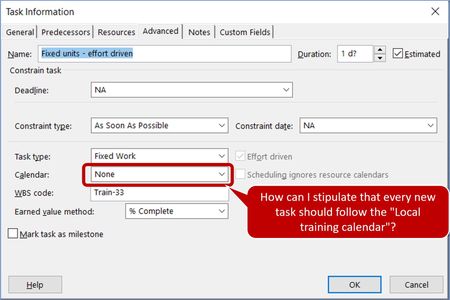

Hi,    For training purposes, I use Project Desktop (version 2309) in offline mode.    Before creating any task, I have set the calendar as follows:  To reflect the fact that office workers wil...
  • John-project's avatar
    Nov 19, 2023

    nvanmaele

    I've got great news for you. An entry of "none" in the Task Calendar field means that task follows the Project Calendar so you're all set.



    If a particular task needs to schedule using a different calendar, then you would set the Task Calendar to be the other calendar.

    Hope this helps.

    John
