Forum Discussion
Need help with Microsoft Project Custom formula for auto populating a custome text field
Folks/Guru's, need some help on getting a custom formula driven auto text based on conditions. The logic I am trying to solve here is
1. Align Tasks based on a given month to align a custom field populate based on condition and reflect it..
Example: Want to lay out a release calendar for key tasks deemed as milestones (zero duration or milestone flag set to "YES" align to R1, R2, R3, R4 in a given calendar year.
Condition is
If Finish Date >= Jan 1st YYYY and < April 1st YYYY then the custom field should show "R1"
If Finish Date >= April 1st YYYY and < June 1st YYYY then the custom field should show "R2"
If Finish Date >= July 1st YYYY and < October 1st YYYY then the custom field should show "R3"
If Finish Date >= October 1st YYYY and <Jan 1st YYYY then the custom field should show "R4"
I need this help at the earliest and please help me out. thanks!
8 Replies
- John-projectSilver Contributor
Try this formula in a custom task Text field.
Text1=Switch(month([Finish])>=1 And month([Finish])<4 And day([Finish])>=1 And day([Finish])<31,"R1",month([Finish])>=4 And month([Finish])<7 And day([Finish])>=1 And day([Finish])<32,"R2",month([Finish])>=7 And month([Finish])<10 And day([Finish])>1 And day([Finish])<31,"R3",month([Finish])>=10,"R4")

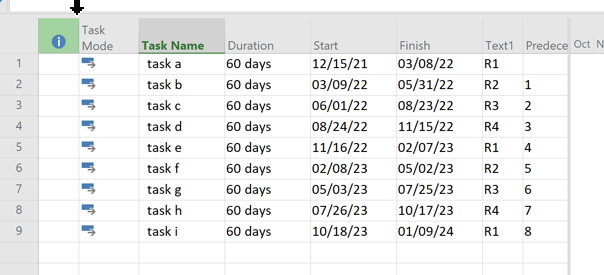

I didn't check it out 100% but here is the result on a quick sample file
John
- John-projectSilver Contributor
Okay, let me know. And if it answers your question, please consider marking my response as the answer.
John
