My calendar keeps returning to working hours of 08:00h to 17:00h even after I set it to 24h?

Hi,

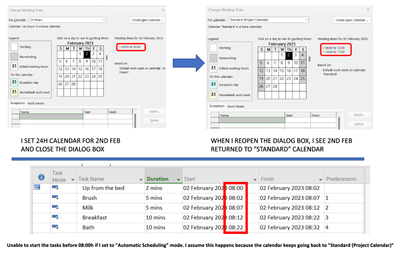

I am new to use MS Project and started doing a trial planning of my daughter's daily routine. I came across an issue of starting her day at 07:00h because it becomes not possible for me to set the calendar to the "24 hours" range. The below image explains my problem better I hope:

How can I get rid of this issue? TIA.



  • Udhaya_K,

    Yeah it can be really confusing for new users of Project.

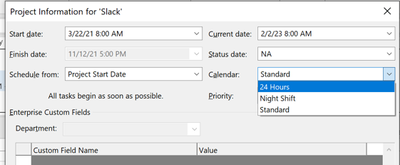

    First, are you really sure you want to use a 24 hour calendar? If so, you do not need to open the Change Working Time window. First, I suggest you go to, File > Options > General group and select a Date Format that includes the time. Then go to, Project > Properties group > Project Information and select "24 hours" as the project calendar. By default the Project Start date always starts at 8:00 am but you can change that to any time you like by editing the Start date time.

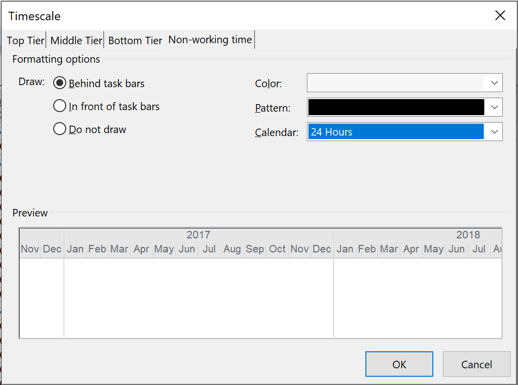

    I should also add that if you want to show the Gantt display with a 24 hour calendar, double click anywhere in the header of the timescale to bring up the Timescale window. In that window select the "non-working time" tab and then select the 24 hour calendar.

    Hope this helps.

    John

3 Replies

  • John-project's avatar
    John-project
    Silver Contributor

    Udhaya_K,

    Yeah it can be really confusing for new users of Project.



    First, are you really sure you want to use a 24 hour calendar? If so, you do not need to open the Change Working Time window. First, I suggest you go to, File > Options > General group and select a Date Format that includes the time. Then go to, Project > Properties group > Project Information and select "24 hours" as the project calendar. By default the Project Start date always starts at 8:00 am but you can change that to any time you like by editing the Start date time.

    I should also add that if you want to show the Gantt display with a 24 hour calendar, double click anywhere in the header of the timescale to bring up the Timescale window. In that window select the "non-working time" tab and then select the 24 hour calendar.

    Hope this helps.

    John
