Forum Discussion

Gilgamesh1964's avatar
Gilgamesh1964
Brass Contributor
Nov 14, 2021
Solved

MS Project VBA Default Location and Default AutoScheduled tasks

Hello,

I have two VBA related questions for MS Project.



1) How do I find the Default File Location?

In Excel it is easy with Application.DefaultFilePath but I can't seem to find an equivalent in MS Project.



2) How can I set the default Task Mode to Auto Scheduled for all new projects?

I know how to do it in the manually in the options but I'm looking for a VBA approach.



Thank You

  • John-project's avatar
    John-project
    Nov 15, 2021

    Gilgamesh1964,

    It is a little strange about the auto/manual scheduling option not being available via VBA, all the other scheduling options are.

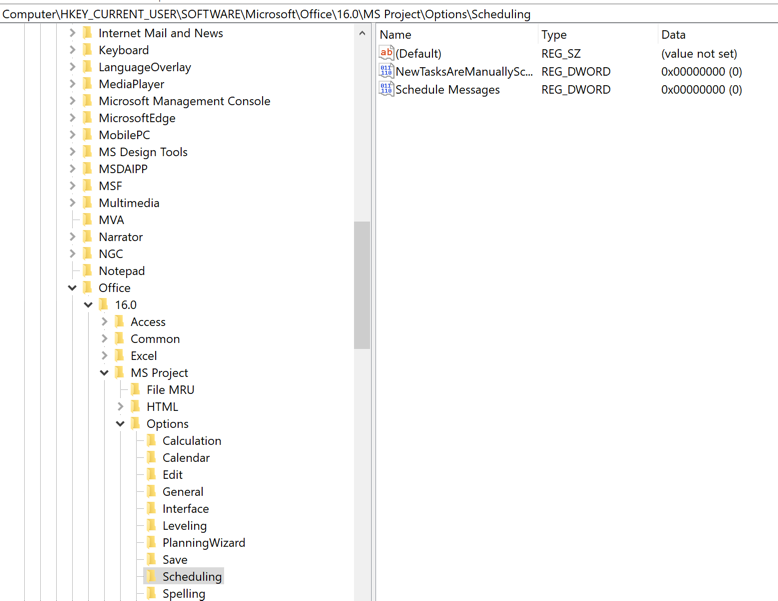

    Yes, you can set auto/manual in the registry. This is what it looks like on my PC, which is currently set for auto schedule.

    John

7 Replies

  • John-project's avatar
    John-project
    Silver Contributor

    Gilgamesh1964

    The default file path for save operations is controlled by the Project options setting. Unfortunately those settings are not readable directly as they are in Excel. I haven't tried this but it may be possible to get the default file path by creating and querying a FileSystemObject.



    Another option is an indirect method and that is simply opening a file you know is in the default location and then using: ActiveProject.FullName



    On your other question, for whatever reason the scheduling mode is not an exposed parameter when setting options using VBA. Sorry.



    Hope this helps.
    John

    • Gilgamesh1964's avatar
      Gilgamesh1964
      Brass Contributor
      Thank you for a quick response.
      I will have a play around with FileSystemObject and see what I can get there.

      On Auto Scheduling, It seems strange to me that something (in my opinion) is so important is not available.
      Do you know if this is stored in a Registry Key, I may try making adjustments there?

      The reason for the questions is that our IT department just installs an out-of-the-box version of MS Project, but our Project Office has some standards. I'm trying to automate setting those standards rather than relying on people who can make mistakes.
      • John-project's avatar
        John-project
        Silver Contributor

        Gilgamesh1964,

        It is a little strange about the auto/manual scheduling option not being available via VBA, all the other scheduling options are.



        Yes, you can set auto/manual in the registry. This is what it looks like on my PC, which is currently set for auto schedule.

        John
