Forum Discussion
sara1201
Dec 19, 2023Copper Contributor
Ms project ressource leveling automatic split

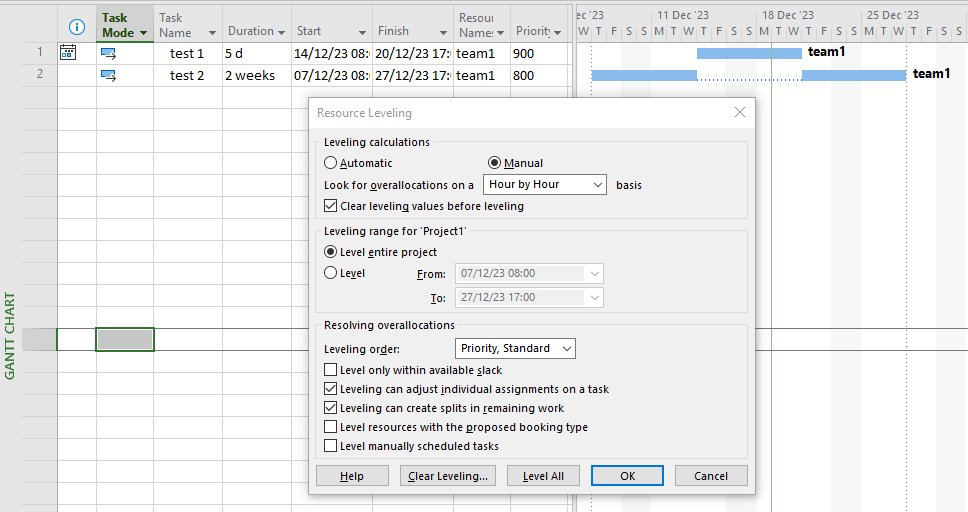

Hello, I am trying to use the feature of Ms project that automatically split remaining work to do with a resource. Here is a very basic example not leveled yet: start date of test 1 is...
- Dec 20, 2023Hi Sara.
If the Task type in test 2 is "Fixed Duration", change it to "Fixed Units" or "Fixed Work" (double click on the task > Advanced tab)
Likewise, try selecting "As Soon As Possible" option in Test2 Constraint type (double click on the task > Advanced tab), because the last image you attached shows a constraint.
N. Option "Leveling can adjust individual assignments on a task", in this case it does not need to be selected. It can be applied when there is more than one assignment (resource) in the same task.
I hope I've helped.
Ignacio
Ignacio_Martin
Dec 19, 2023Iron Contributor
- sara1201Dec 20, 2023Copper Contributor
- Ignacio_MartinDec 20, 2023Iron ContributorHi Sara.
If the Task type in test 2 is "Fixed Duration", change it to "Fixed Units" or "Fixed Work" (double click on the task > Advanced tab)
Likewise, try selecting "As Soon As Possible" option in Test2 Constraint type (double click on the task > Advanced tab), because the last image you attached shows a constraint.
N. Option "Leveling can adjust individual assignments on a task", in this case it does not need to be selected. It can be applied when there is more than one assignment (resource) in the same task.
I hope I've helped.
Ignacio- sara1201Dec 20, 2023Copper ContributorHello Ignacio,
It worked now ! thank you so much !
