MS Project report view tasks in next 30 days...
- Jun 23, 2021
You can view the construct of the "tasks starting soon" filter by going to, View > Data group > Filter selection box > "tasks starting soon".
As far as creating a 30 day lookahead filter, here is one way to do it. First create two custom date fields
Date1 = [current date]
Date2 = [current date] +30

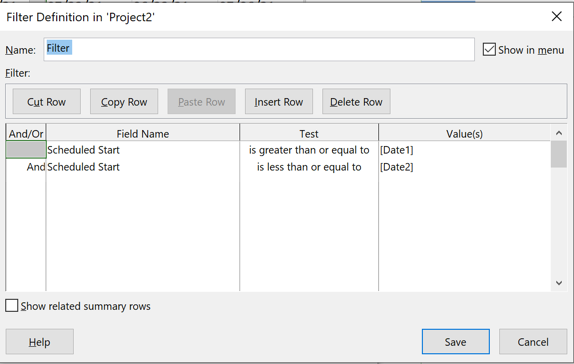

Then create this filter:John
You can view the construct of the "tasks starting soon" filter by going to, View > Data group > Filter selection box > "tasks starting soon".
As far as creating a 30 day lookahead filter, here is one way to do it. First create two custom date fields
Date1 = [current date]
Date2 = [current date] +30
Then create this filter:
John
- Nidhi320Jun 18, 2024Copper Contributor
John-project Hi John, how to create the following?
First create two custom date fields
Date1 = [current date]
Date2 = [current date] +30- John-projectJun 18, 2024Silver ContributorNidhi320,
What version of Project are you using? If you don't have the desktop version of Project or Project Online (not Project for the Web) then you won't be able to use the process I outlined above.
John
- Miss_HeFeb 22, 2024Copper Contributor
thank you John-project, that's very helpful.
I tried with your instructions, and it works for the tasks due within this month. However, the report doesnt show all the tasks meet the criteria. Could you please help on this?
Many thanks!
He
- John-projectFeb 23, 2024Silver ContributorMiss_He,
I need a little more information. What exactly are you trying to accomplish? A screen shot showing where you think certain tasks aren't being flagged might help.
John
- James_PriceJun 23, 2021Brass ContributorNice one. Thanks John
James
