Forum Discussion

yash dutt's avatar
yash dutt
Copper Contributor
Dec 08, 2017

MS Project 30 60 90 day lookahead

Hi All,



I am new to Project Management as I have started a new role as a Project Lead and this is all new to me coming from a tester background.



I have been tasked with finding a way on MS Project to show tasks that are due in 30 60 and 90 days, however I have no ideas. I was wondering if anyone has a way of doing this on a existing project.



any other advice is welcome...



Thank you All!!



Yash Dutt

2 Replies

  • Deleted's avatar
    Deleted
    Not applicable

    Yas



    You can do a 30, 60 day look up



    I use this flag and view for a 4 week look ahead

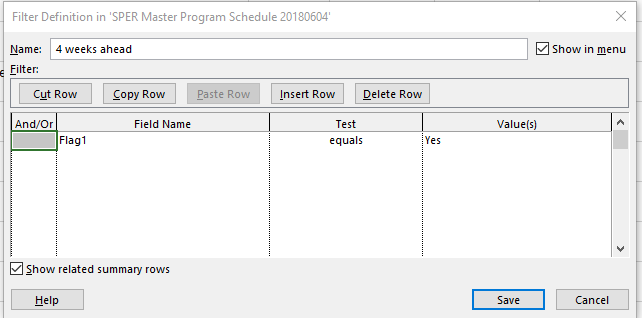

    Create a Flag custom field with the following formula (you can change the 4 weeks)



    IIf(([Start]>=DateAdd("ww",-1,[Status Date]) And [Start]<=DateAdd("ww",4,[Status Date])) Or ([Finish]>=DateAdd("ww",-1,[Status Date]) And [Finish]<=DateAdd("ww",4,[Status Date])),Yes,No)
