Forum Discussion

nati2009's avatar
nati2009
Copper Contributor
Jul 05, 2023

ms project - rent a tool for half day

hi



i have many tools that i rent at cost per day when i need them just for 0.5 day

for example i need a bomag for 0.5 day but the cost for rent bomag is 300usd per day

so when i enter resources for a task in the ms project its calculte it as  0.5 (day ) *300 (cost ) usd so its 150 usd , even that i set the resources to 300usd/day at the resources sheet



how can i set at ms project that if i use the bomag resources even if it for 0.5 day its will cost me like full day ?



i cant do it like " cost per use " beacuse i have many tools like that and i change the work time a lot

  • John-project's avatar
    John-project
    Silver Contributor

    nati2009,

    Even though at resource rate may be set for cost per day or cost per hour, internally Project calculates all time related data to the nearest minute. For example, a resource rate of $1/hr will show a cost of $.016 (rounded to $0.02) for a task with a duration of 1 minute.

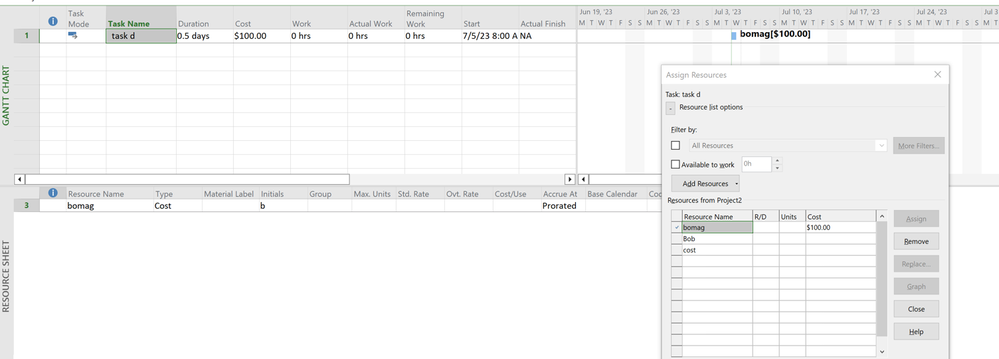

    If you don't want to use the "cost per use" then I suggest you set up your tool costs as cost type resources. In this example the bomag is a cost type resource so no rate is given. When the bomag is assigned to a task,  the rate is set in the Cost column of the Assign Resource window. This cost will be fixed regardless of the task's duration.

    Hope this helps.

    John
