Forum Discussion

MikeT67's avatar
MikeT67
Copper Contributor
Sep 13, 2022

Late predecessors filter

I have a project file that is used to provide a current status of our annual budgeted projects. Tasks are limited to "preparation of submission" > "approval 1" > "approval 2" > "approval 3" > project execution. They are all linked and scheduled "late as possible" all working back from the completion date of "execution". I want to filter so that only the task that is holding each of the projects up is shown in a report or dashboard.



For example if the submission is complete but not approval 1, I don't want to show the late linked successors as well. My intent is to provide a report for each of the stakeholders showing projects that are waiting on them and holding others up and not their tasks that they cant do because of a late predecessor. Any help greatly appreciated



Cheers,



Mike

  • MikeT67

    I think it's interesting that the subject of your original post has nothing to do with what you really wanted or the final solution. But, I think we finally got to the bottom of it all, (or maybe the top), and here's what I have for you.



    This is the sample test file with progress on some tasks, some complete and a couple in progress. The Status Date is set to 9/9/22.

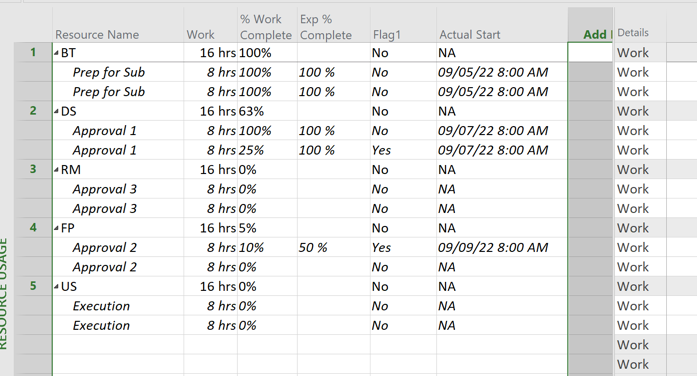

    This is what the Resource Usage view shows after the macro is run to find the "late" resources. A "late resource" is defined as reported % Complete less than "expected" percent complete and "expected" percent complete is defined as linear cumulative progress from task start to the status date expressed as a percent of total task duration. For reference, the resource assignment Flag1 field is renamed as "Exp % Complete".

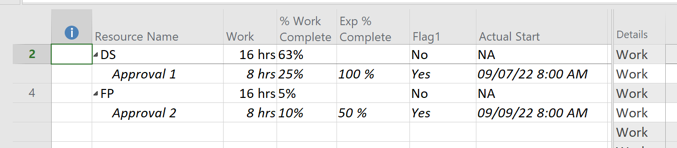

    With a custom filter set to look for resource Flag1 and showing related summary (i.e. resource) rows, this is the result.

    Is this awesome or what?

    John

    Oh yeah, I almost forgot. And here's the macro that does it:

    Option Explicit
    Sub MikT67Special()
    'Macro written by John-Project for Aussie Mike
    '9/16/22 4:00 PM MST
    'This macro examines all resource assignments and sets the resource assignment Flag1 true
    ' if the task is on-going (i.e. not complete) and reported progresss (i.e. % Complete) is less
    ' then expected percent complete. Excpected percent complete is defined as linear cumulative duration
    ' from assignment start to Status Date.
    Dim r As Resource
    Dim a As Assignment
    Dim DtDif As Single
    Dim PlanPer As Single

    For Each r In ActiveProject.Resources
    If Not r Is Nothing Then
    For Each a In r.Assignments
    'reset tresource assignment flag from previous run
    a.Flag1 = False
    'only look at on-going assignments
    If a.ActualStart <> "NA" Then
    DtDif = Application.DateDifference(a.ActualStart, ActiveProject.StatusDate)
    'check if assign should have finished and if so, normalize planned percentage
    If a.Finish < ActiveProject.StatusDate Then DtDif = a.Task.Duration
    PlanPer = DtDif / a.Task.Duration * 100
    'write expected completion to assignment Text1 for reference
    a.Text1 = PlanPer & " %"
    'flag task that is "late" per expected completion as of status date
    If a.PercentWorkComplete < 100 And a.PercentWorkComplete < PlanPer Then a.Flag1 = True
    End If
    Next a
    End If
    Next r
    End Sub

  • John-project's avatar
    John-project
    Silver Contributor

    MikeT67

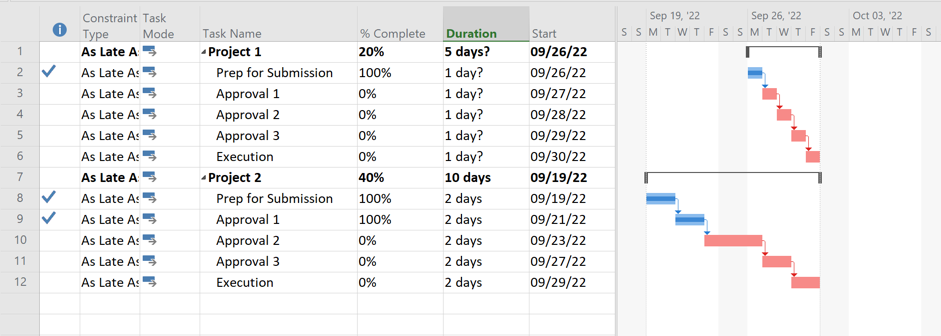

    This is a mockup of what I interpret your plan might look like.

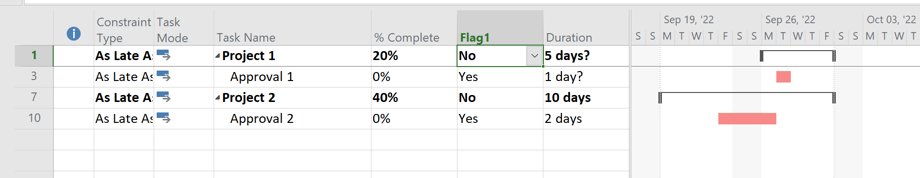

    If I further understand you want to display only task ID 3 in Project 1 and task ID 10 in Project 2 since they are the limiting tasks. Something like this.

    The only way I know to create this is with a simple macro that identifies the relevant tasks and creates a filterable field.



    If the above is not what you have or not what you want then please expand with some example screen shots.



    John

    • MikeT67's avatar
      MikeT67
      Copper Contributor

      John-project

      This is the report that I include in a dashboard. I want to show a summary of late tasks for each resource but exclude any with a late predecessor. In other words, I only want to show who is holding the project up not all the dependent successors that are waiting. It is all simple finish-start so a dependent task cant start until the predecessor finished. What it does at the moment is provide a summary of all late tasks for each resource even on the tasks where they are waiting on someone else. Technically that is correct but as it is a dashboard I want to summarize to the resource the task is with. It is just getting too long the way I have it. It captures a year worth of projects and on average there would be 50 of them. Thank you so much for looking at this! Cheers, Mike



      • John-project's avatar
        John-project
        Silver Contributor
        Mike,
        Sorry, I'm not quite following what you say. Remember, I not in your head so I can't see what you see (or what you're thinking). The screen shot you show looks like a grouped view (perhaps a customized report you created with Project's report features). It is showing what you want to see or what you do see?

        Can you show me a marked up Resource Usage view?

        John

Resources
