Interference Problem

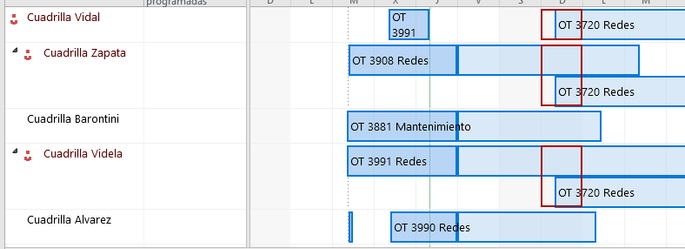

Hello everyone. I have a problem with interferences. As you can see in the image above, i have an interference in 3 resources (Cuadrilla Vidal, Zapata y Videla). These 3 resources all work only from Monday to Friday, and they have their own calendar (and it works, or seems to). Now, the problem is that they have to do a task on SUNDAY. And this task may take up to 3 sundays. So i created a calendar for this task, and it works too, it only programs the task to do it on sundays, but i don't know why, Project says there is an interference, when on Sunday the only task that they are doing is the special one.





Can someone give a hand? I tried manually changing the calendar of the all the other tasks to Monday - Friday, but didn't solve it.



THANKS!!



Mark.



1 Reply

  • Marco --

    Could you show us the calendar that you set up for the Sunday-only work? I suspect that might be the problem. Let us know and we will try to help you.
