How to get Project to assign Day Shift then Evening Shift then Night Shift
Hi All, I just joined last week - Thanks Lana at the Toronto Tech Summit I am setting up a schedule for a 24/7 job so there is: Day shift 8 am till 4 pm Even shift 4 pm to Midnight Night shift M...
Mehdi HAMMADI
Nov 07, 2016Brass Contributor
Hi,
Try this,

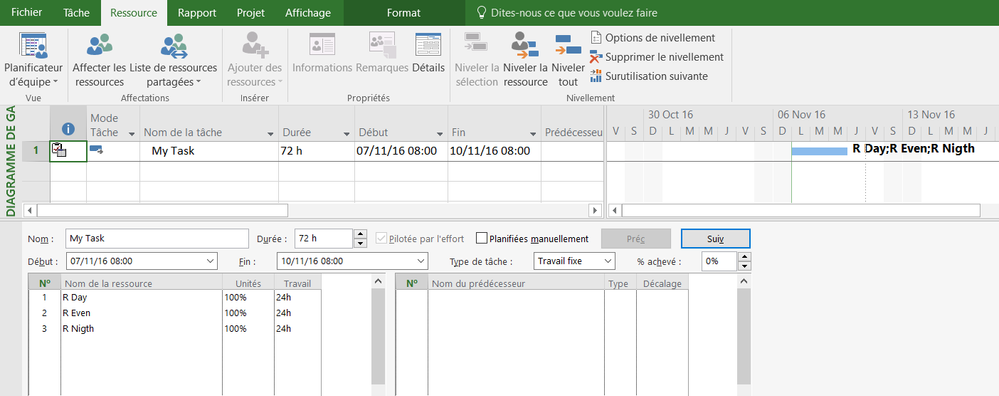

Create a task with this setting
- Schedule mode : auto schedule
- Task calendar : 24 Hours
- Task type : Fixed Work
- Task duration : 72 hours (03 days and nights)
Create 03 ressources,
- Set to each one, one of the calenders you created 'Day', 'Even' and 'Night'
Assign the 03 ressources to the task
- Adjust the working time of each ressource to 24 hours (03 days x 08 hours per day)
Bert Joe Twomey
Nov 08, 2016Tin Contributor
Thanks Mehdi, it works good
