How to get Project to assign Day Shift then Evening Shift then Night Shift
Hi All, I just joined last week - Thanks Lana at the Toronto Tech Summit I am setting up a schedule for a 24/7 job so there is: Day shift 8 am till 4 pm Even shift 4 pm to Midnight Night shift M...
Mehdi HAMMADI
Nov 07, 2016Brass Contributor
Hi,
Try this,
Create a task with this setting
- Schedule mode : auto schedule
- Task calendar : 24 Hours
- Task type : Fixed Work
- Task duration : 72 hours (03 days and nights)
Create 03 ressources,
- Set to each one, one of the calenders you created 'Day', 'Even' and 'Night'
Assign the 03 ressources to the task
- Adjust the working time of each ressource to 24 hours (03 days x 08 hours per day)
WaaWaaW
Jan 20, 2021Copper Contributor

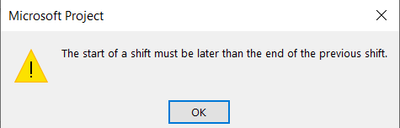

hiMehdi HAMMADI, when I do the 24 hours calendar and change the time manually to
5 pm to 12 am
12 am to 2 am
they said like this,
can u help me too?
- John-projectJan 20, 2021Silver Contributor
Try reversing your entry
12 am to 2 am
5 pm to 12 am
Some versions of Project will automatically reverse the sequence to the above even if you entered it the other way but apparently your version does not, instead it gives you an alert.
Hope this helps.
John
