How to delete/remove Team Member from a Project in Project for the Web?
Hello, We're using the Project for the Web accelerator Power App. A bookable resource can be added directly to a Project via the Project's Resources tab or if they're assigned to a Task. When...
Jan 26, 2023
Adil365 --
I believe the only way to remove a team member from the project group would be by someone who has permissions to do so with Office 365 Groups. It is not possible to remove team members in Project for the Web. Hope this helps.
I believe the only way to remove a team member from the project group would be by someone who has permissions to do so with Office 365 Groups. It is not possible to remove team members in Project for the Web. Hope this helps.
Neil_Kelly
Jan 26, 2023Copper Contributor
Dale_HowardMVP ah interesting. I assumed since adding a team member adds to the office group. It would do the reverse automatically. I'll try removing from the group first and see whether it's possible then. Thanks for the suggestion. I'll report back here. To confirm either way.
- DannyWiederMar 21, 2023Copper ContributorHi Neil - did you manage to get anywhere with this? We have the same issue.
- Karen_McCrackenJul 10, 2023Copper ContributorHi Neil - We also have the same issue. Any help would be greatly appreciated.
- DannyWiederJul 10, 2023Copper Contributor
Karen_McCracken - Hi.

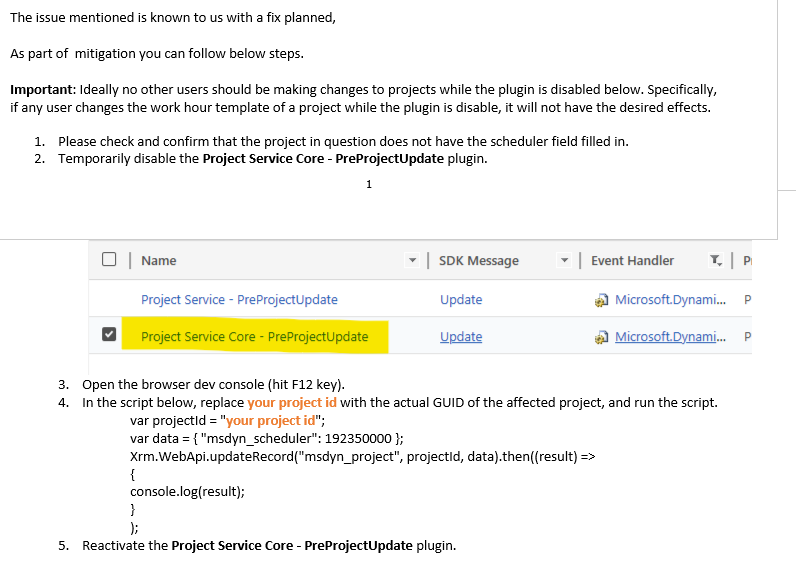

I had the reply below from Microsoft and it worked (in the past this was possible from the UI). Hope this helps.
- In the script below, replace your project id with the actual GUID of the affected project, and run the script.
var projectId = "your project id";
var data = { "msdyn_scheduler": 192350000 };
Xrm.WebApi.updateRecord("msdyn_project", projectId, data).then((result) =>
{
console.log(result);
}
);
- Adil365Jan 27, 2023Copper ContributorLook forward to hearing back from you with your findings!
