Forum Discussion

Tony_Platts's avatar
Tony_Platts
Brass Contributor
Mar 18, 2022
Solved

Hours v Days - A little advice required on managing multiple projects concurrently

Hi there,

In previous roles I've always run a single project at a time or I've had a fixed number of hours each day to dedicate to a project.  This allowed me to put the number of days into a project and use the automatic scheduling feature to tell me which days tasks would take place on.



In my new role things are very different. I'm currently running 5 projects concurrently using different teams. Those teams are also working on other projects and I don't manage the project plans for anything other than my own projects. To accommodate this I tend to allocate a few days to a task even though the task itself only takes a few hours.



As an example. I may have a task that takes 3 hours to perform. I need it done on either Monday, Tuesday or Wednesday.  I'll set the task in the project plan to 3 days long and assign it to a resource. This really works for the clients because they know that, between those three days, we're going to be working on this task. It works for my team who are able to schedule their own days as they want to.



The problem is that we're now trying to use MS project as an output to our planning sessions and I want to be able to go into the resource sheet and say "I need this person 3 hours this week" but I can't rely on the plan because 24 hours is assigned.....3 days at 8 hours each.



I cannot assign them a work rating of 25% because they don't work a set period of their day on any project.

I don't want to use Manual Scheduling because, if something slips, I don't want to have to go through every start and finish date myself.

I could add a task of 3 hours and set lag on the task of 3 days but this seems inefficient.



Can anyone recommend a way of doing this? I need to give my team a window to complete a task whilst still capturing the amount of work, and I need it to be flexible.



Happy for you to just tell me or direct me to a resource to watch/read.



Many thanks.

5 Replies

  • John-project's avatar
    John-project
    Silver Contributor

    Tony_Platts,
    Sounds like a perfect application for a fixed duration task. In your example, set the fixed duration to 3 days and set the work to 3 hours. When you assign a resource at 100% Project will linearly spread the 3 hours over the 3 day period. Whether the resource actually works 1 hour each day or 3 hours on any of the 3 days doesn't matter, you've captured the intent.



    You may also find this thread and discussion helpful:

    https://techcommunity.microsoft.com/t5/project/fixed-duration-task-effort-driven-why-is-the-3rd-resource-set-at/m-p/3256500

    Hope this helps.
    John

    • Tony_Platts's avatar
      Tony_Platts
      Brass Contributor

      Sorry John, I think I need a little more help if you can assist.

      I've set the task back to Automatically Scheduled. I've set the task type to fixed duration. The duration is set at 1 hour, the length of time to do the task. How do I allocate the two days, which is the amount of time we've allowed the engineer to perform that 1 hour task?

      Many thanks.



      Edit: Sorry, I've re-read your message and I've set the duration to 3 days. Still not seeing where I update the "Work" to 1 hour.

      • John-project's avatar
        John-project
        Silver Contributor

        Tony_Platts

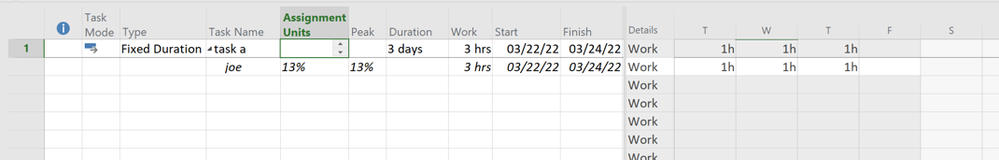

        Hopefully this example will answer your latest questions. I first set the task type, then the duration, then the work, and then assigned the resource "Joe" at 100%. Doing so let's Project calculate the actual assignment level to meet the duration and work values (i.e. 13%). This is the result in the Task Usage view.

        John
