Having problem with linking the tasks in project tool
- Apr 12, 2024
- mintvivekApr 13, 2024Copper Contributor
Wow, it worked. Thanks a Lot Ignacio. Could you also help me in understanding how this function works? That would be a great help.
Regards,
Vivek
- Ignacio_MartinApr 14, 2024Iron Contributor
Hello Vivek

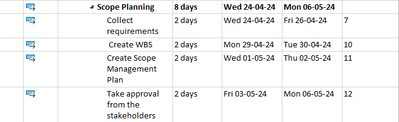

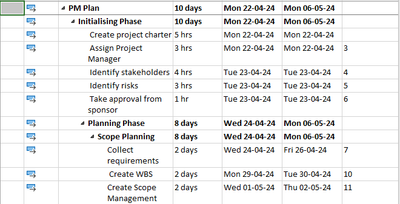

In Ms Project, the Duration of a Summary task is the difference in working time, shown by default in working days, between its Start date and its Finish date, counted in the calendar assigned to that summary task, by default the Project Calendar .
The Start date of a Summary task is the earliest Start date of all the tasks it groups together.
The Finish date of a Summary task is the latest finish date of all the tasks it groups together.
Logically, a task that has a higher outline level than another that is next in the list is a Summary task, and is shown by default in bold.
Optionally, you can insert the Outline Level column in the task table, or the Outline Number to check it.
I hope you find the explanation useful.If you agree, at the bottom, you can click Like or Best Answer.
Ignacio- mintvivekApr 15, 2024Copper Contributor
Thank you so much Ignacio for the explanation. I have no words to express my gratitude and respect for you. Still, I can say you are the best.
