Forum Discussion

ymt19's avatar
ymt19
Copper Contributor
Oct 18, 2022
Solved

Gantt Chart Conditional formatting

Hello,    I am trying to add a conditional formatting rule to my gantt chart within MS Project. Basically, I want the task bars within the Gantt chart section to be automatically highlighted in a d...
  • ismet_kocaman's avatar
    Oct 18, 2022

    ymt19

    This is Flag1's formula: Int( [Finish] ) < Int( now() ) And Not [% Complete] = 100

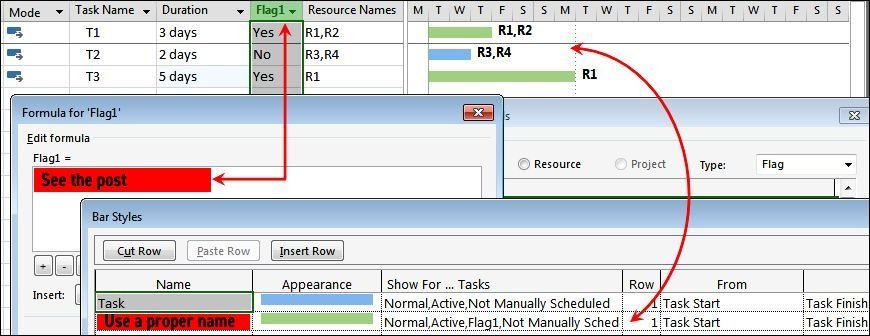

    See the picture below in order to see how to define a new bar style controlled by Flag1.
