Forum Discussion
Nicolas_JOURJON
Jun 30, 2023Copper Contributor
Find out the remaining work on a linked task in another file
Hello, I have a problem when I link tasks on two different files on MS Project. I have a file A with tasks 1, 2 and 3 and a file B with the link on tasks 1, 2 and 3 of file A. The start dates a...
- Jul 07, 2023Nicolas,
I'm sorry you are having difficulty trying to decode my address. Take another look at what I provided, there is no "john.project". If and when you figure it out do NOT post it to this, or any other, forum.
John
John
Nicolas_JOURJON
Jul 04, 2023Copper Contributor
Thank's a lot for your answer. The two files are very long (around 600 row each) and it's impossible to insert both project in only one. I have to try the VBA thing!! I learned it (long time ago) and hope I will find the way to write and insert it in the project.
Nicolas 😉
Nicolas 😉
John-project
Jul 04, 2023Silver Contributor
Nicolas,
Impossible? I don't think so. A Project file with 600 task rows is not a large file and there should be no reason why two such files couldn't be inserted into a static master.
Nonetheless, if you want to go the VBA route and need some help, let me know.
John
Impossible? I don't think so. A Project file with 600 task rows is not a large file and there should be no reason why two such files couldn't be inserted into a static master.
Nonetheless, if you want to go the VBA route and need some help, let me know.
John
- Nicolas_JOURJONJul 07, 2023Copper ContributorHello again,
I realy don't find your email adress.... I try more than 20 times !
With .icoud.com and the begining that I undertand... (not well I think)
I will go to weekend and I'll try monday, maybee the weekend is good to think.
Nicolas - John-projectJul 07, 2023Silver ContributorNicolas,
I'm sorry you are having difficulty trying to decode my address. Take another look at what I provided, there is no "john.project". If and when you figure it out do NOT post it to this, or any other, forum.
John
John - Nicolas_JOURJONJul 07, 2023Copper Contributor
On of the email address I test is the one that you can find enclose.
To be frank, the weekend I will profit of the good weather and shouldn't work.
I'll continue monday I think. And try on my side but no so easy...
Nicolas
- John-projectJul 07, 2023Silver ContributorNicolas,
I did not receive an e-mail from you. Compare my encoded e-mail to a normal e-mail address, that should help you figure out what my address is.
I'm tied up today but I will likely have time to look at your stuff this weekend. Will you be available?
John - Nicolas_JOURJONJul 07, 2023Copper Contributor
- Nicolas_JOURJONJul 07, 2023Copper ContributorJohn,
I send you an email and I didn't Know if you recieved it. (Maybe a mistake in your email adress).
I would like to have a VBA programme that put a 0 in the data "Work" on the RTP file on MS project. And then put the RemaingingWork of the Master file in the same line on the RTP file.

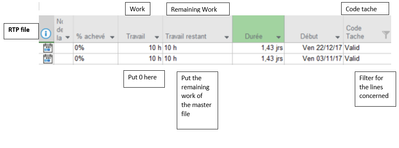

The tasks concerned are the tasks with the field "Code task" fill with "Valid". See the picture enclose.
Thanks,
Nicolas - John-projectJul 05, 2023Silver ContributorNicloas,
I got a little "break in the action" so I'll give a quick reply.
You're right, having a resource pool file shouldn't impact what you are trying to do but many times a user poses a question without giving us full "disclosure" on their file structure and often it can make a big difference on how we respond.
You might want to try contacting me directly again now that I explained how to un-encode my address. If you need help with your macro code I'll need to see what you have.
For reference I'm in the United States. I assume you are in France so we have about a 9 hour difference and yes, that does mean a limited window for communication.
John - Nicolas_JOURJONJul 05, 2023Copper ContributorHello again,
We use a "Ressource file" but I think that it doesn't matter for the job.
I begin to do VBA, and it's not a total mess.
I have some difficulty to erase the wrong "remaining work" on RTP file... and to replace it.
thanks,
Nicolas.
Juste for my curiosity, where you come from? - John-projectJul 05, 2023Silver ContributorNicolas,
I encode my e-mail to thwart SPAM bots. Instead of the @ I spell it out ("at") but duplicate it as part of the encoding. I also duplicate the normal "." as part of the encoding.
I opened the files you zipped and posted. You didn't mention you are also using a resource pool. I'm committed on other tasks this morning so it may be a while before I can comment further.
John - Nicolas_JOURJONJul 05, 2023Copper Contributor
- Nicolas_JOURJONJul 05, 2023Copper ContributorHello John,
We have around 15 people (RTP) who work on 20 projects (in total). One or two by RTP. All the RTP don't have exactly the same format but the main informations are presents.
For my point of vew, I should work with the solution N°2 : "Create two schedules and link the Master schedule with the task address in the RTP file." with a marco to have the good "remaining work". I have to keep RTP files and one validation file, and no additionnal file.
I am sorry but I can't send you the original files. Just the simplifided files.
I try to understand your email adress... But I have some difficulty to understand!
dotdor -> . but there are not @ ?
I send you the two simplified files RTP and Master (it's Validation) - John-projectJul 04, 2023Silver ContributorNicolas,
I don't think we're quite on the same "page" with respect to creating the static master. First of all I was under the impression you had one RTP file and one validation file. Having 20 RTP files does increase the size but it would NOT have any impact on the size of the validation file. All 20 RTP files AND the validation file would be inserted into a separate master file, so that file would have 120,000 task lines plus however many task lines are in the validation file. That would be a very large file but nothing that Project could not handle.
However, given that new information, if I were trying to do what you want to do I would definitely go with a VBA approach. Would you be willing to send your files to me (one RTP and the validation file)? Then we could work one-on-one. You can contact me at the address below. I will ask some questions.
John
jmacprojataticlouddotdotcom
(remove obvious redundancies) - Nicolas_JOURJONJul 04, 2023Copper ContributorHello again,
We have around 20 RTP files, 600 rows each and one Validation file. The validation don't want to have 12000 row in his file. I try to write VBA code but after amost 12 years, it's hard to be in.
If you have a proposal it will be nice 😉
Thank's
Nicolas
