Forum Discussion
Capacity Planning issue
- Jan 06, 2022
I had logged a call with Microsoft. The below steps helped me resolve the issue:
- PWA Change the capacity planning ahead of 6 months and 4 months before.
- Go to the production APP site setting -> Site collection features
- Disable the Project webapp and setting site collection feature of the PWA and then again enable it
- Ran the following command to check the provisioning state of the PWA get-spprojectwebinstances
- The main PWA provisioning state should be online now.
- After That run the project resource planning sync timer job by going to the Central Admin->Monitoring->Job definition
- Check the resource planning sync job in PWA queue job ,
- Cancel all the failed and blocked jobs.
- Then wait for some time to let this resource planning sync job to success.
AmitWairkar1 i have the same problem.
One of my users is trying to use the Capacity Planning and he get's the same message.
I am the administrator and i've configured it for over a week on PWA Aditional Server Settings with 12 months behind and another 12 months ahead... but the problem persists.
Really don't know what else to do.
Could someone please help?
I had logged a call with Microsoft. The below steps helped me resolve the issue:
- PWA Change the capacity planning ahead of 6 months and 4 months before.
- Go to the production APP site setting -> Site collection features
- Disable the Project webapp and setting site collection feature of the PWA and then again enable it
- Ran the following command to check the provisioning state of the PWA get-spprojectwebinstances
- The main PWA provisioning state should be online now.
- After That run the project resource planning sync timer job by going to the Central Admin->Monitoring->Job definition
- Check the resource planning sync job in PWA queue job ,
- Cancel all the failed and blocked jobs.
- Then wait for some time to let this resource planning sync job to success.
- DavidGarcezJan 07, 2022Copper Contributor
AmitWairkar1 Thank you for your help, but i ran in some problems:
- PWA Change the capacity planning ahead of 6 months and 4 months before. DONE!
- Go to the production APP site setting -> Site collection features DONE!
- Disable the Project webapp and setting site collection feature of the PWA and then again enable it - Cant find this feature, but tried the similar ones.
- Ran the following command to check the provisioning state of the PWA get-spprojectwebinstances DONE on Sharepoint Management Shell
- The main PWA provisioning state should be online now. DONE!
- After That run the project resource planning sync timer job by going to the Central Admin->Monitoring->Job definition DONE!
- Check the resource planning sync job in PWA queue job , Can't find this job.
- Cancel all the failed and blocked jobs.
- Then wait for some time to let this resource planning sync job to success.
- AmitWairkar1Jan 10, 2022Copper Contributor
7. Check the resource planning sync job in PWA queue job
Steps: Central Admin --> monitoring -->review job definitions -->Scheduled jobs --> select view - job definition -->job definition - change job definition --> search for Project Server: Capacity refresh job for XYZ_servername.

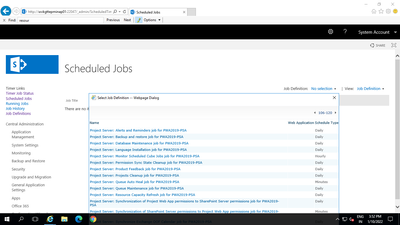

Check the below screenshot for reference.
You can enable the refresh job and set a daily refresh frequency.
Regards,
Amit Wairkar
- DavidGarcezJan 10, 2022Copper Contributor
AmitWairkar1 Thank you again for your time.
That's the thing, i don't have that job on my Job Definitions...
Is it possible to add it?
Kind regards;
David Garcez.
